January 25, 2025
5 photo

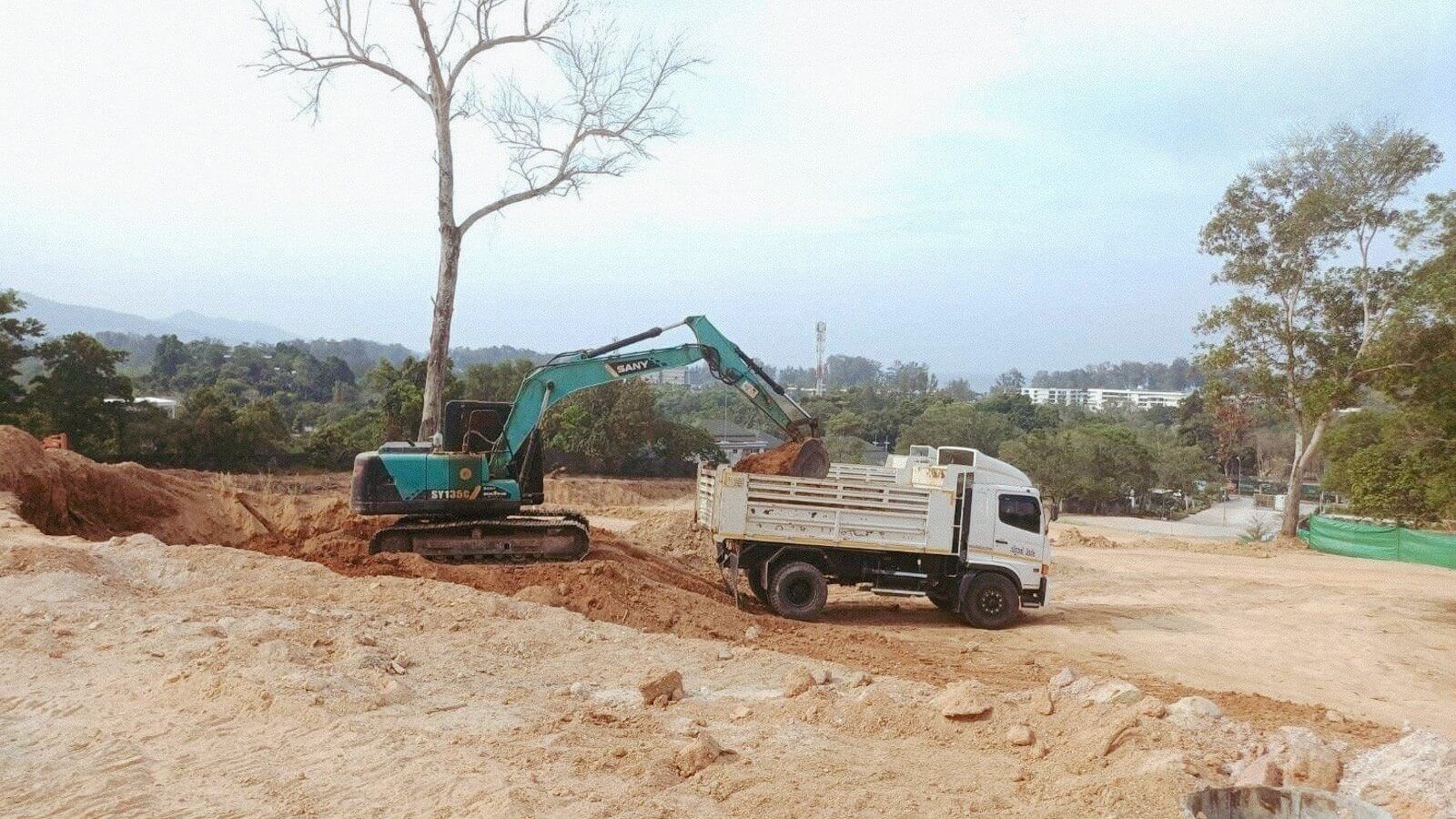

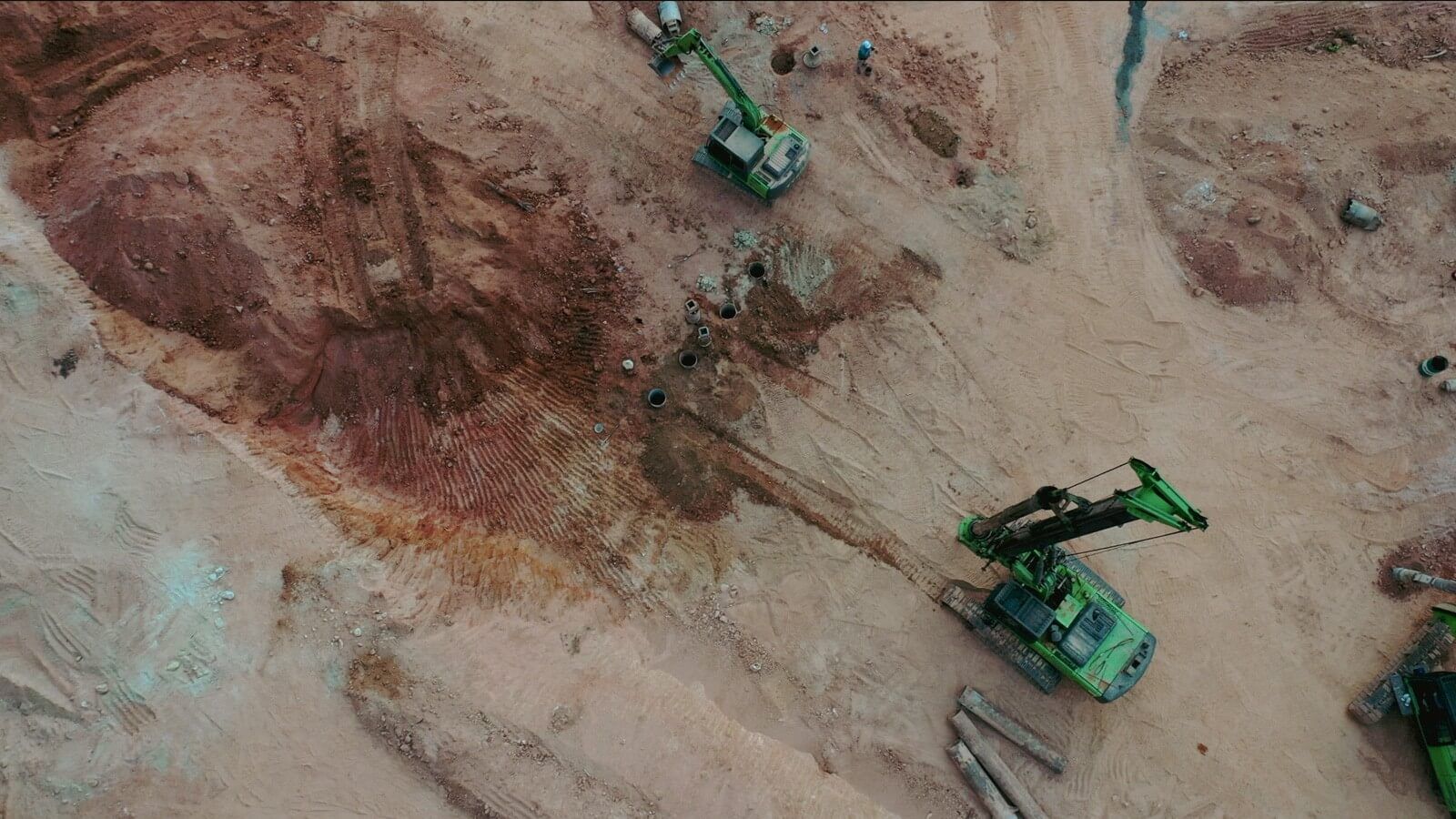

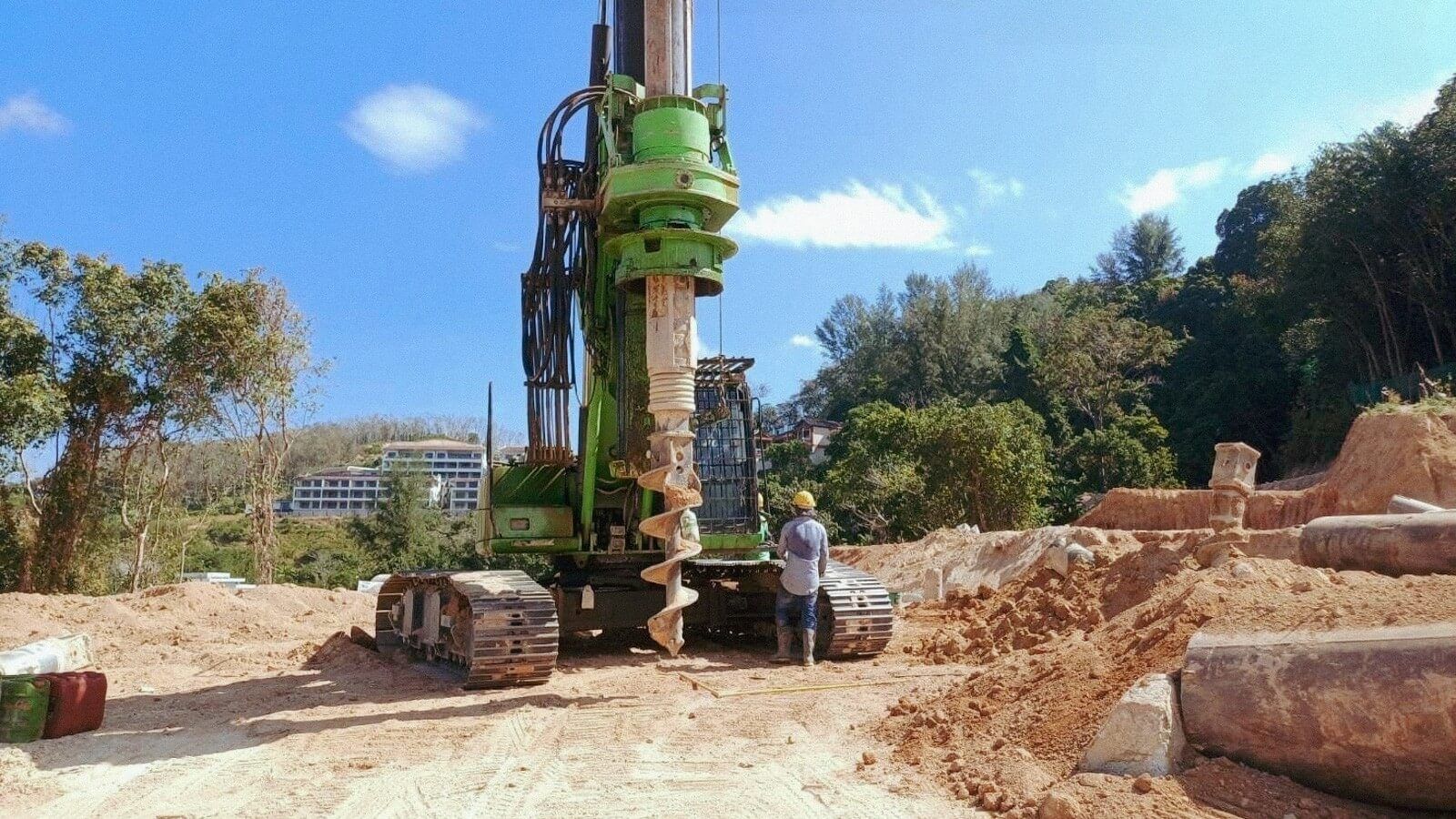

Installed 570 piles. The installation of the A5 building is 100% complete, and work on other sites continues. Excavation of the first stage was carried out at 58% of the total volume, 43144m³ were removed.

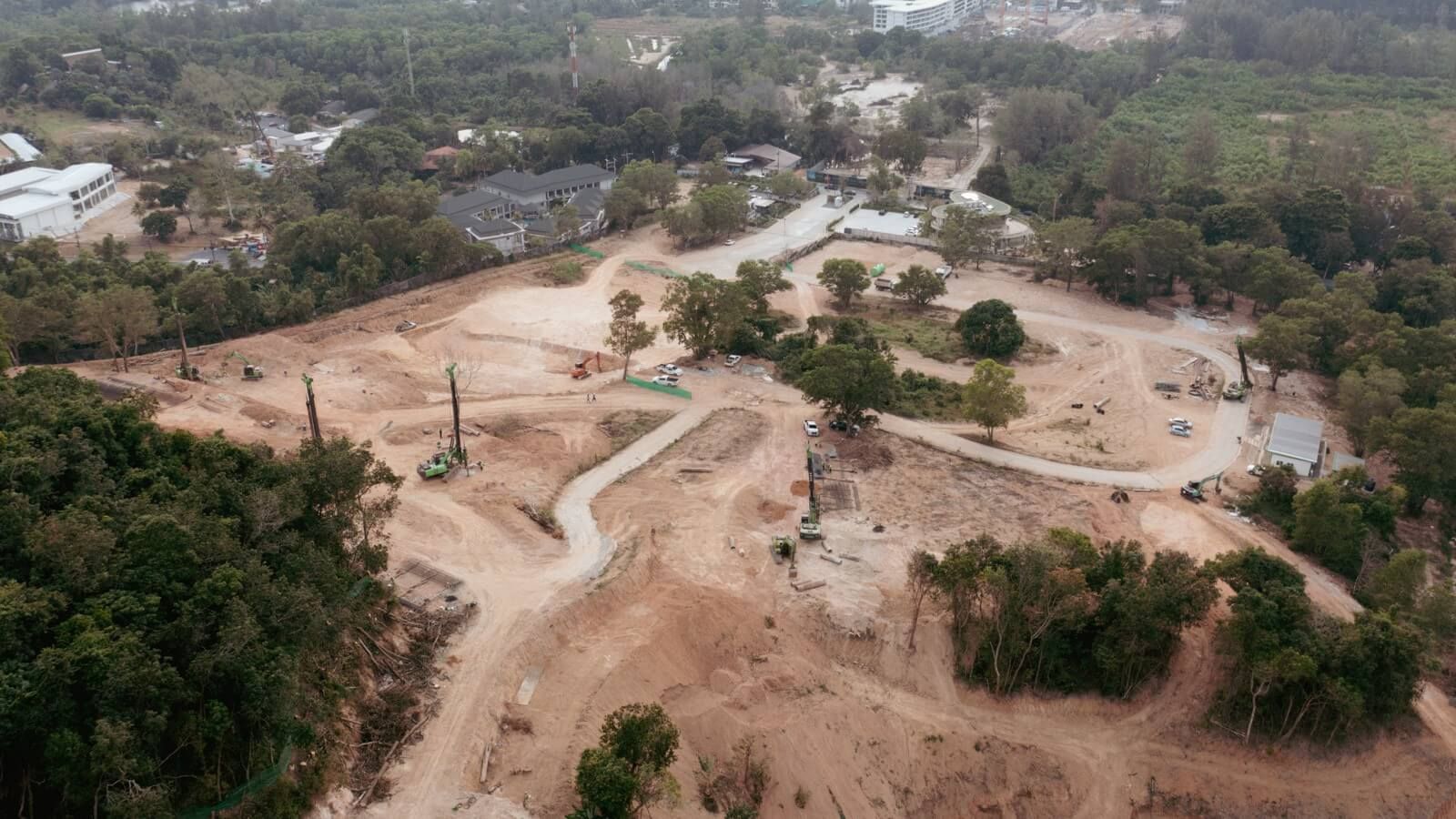

February 11, 2025
5 photo

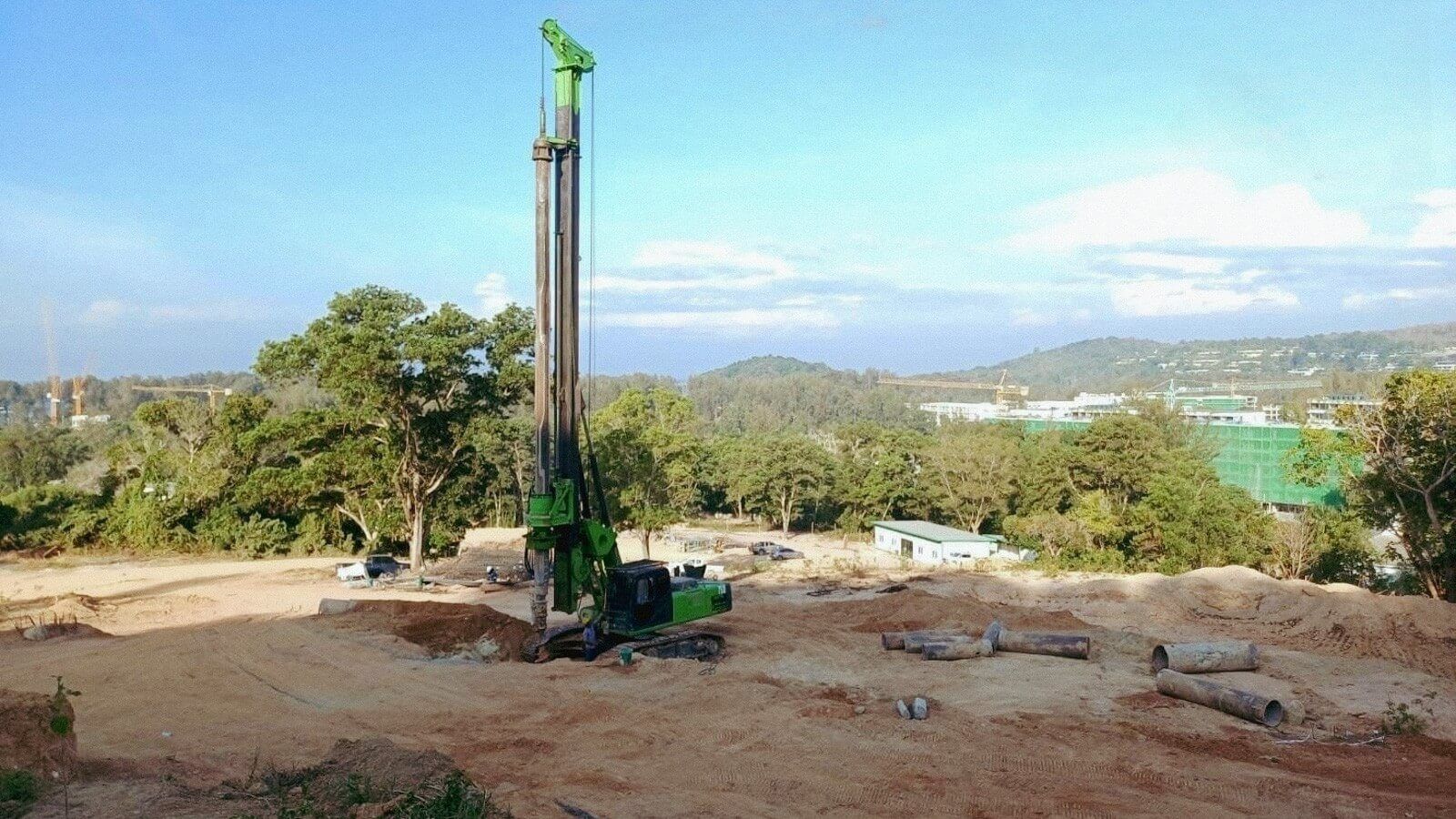

January 7, 2025
4 photo
