February 26, 2025

5 photo

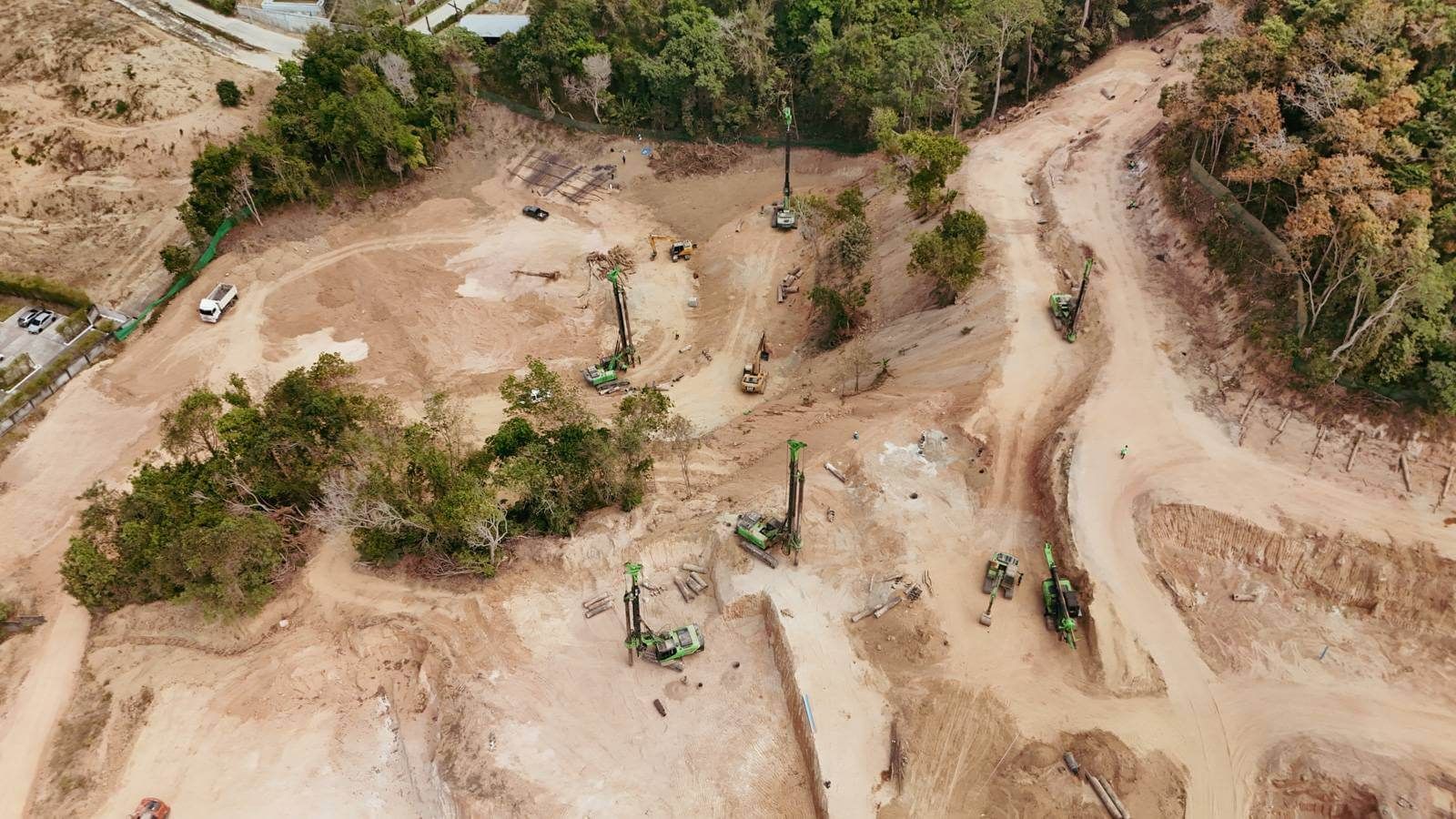

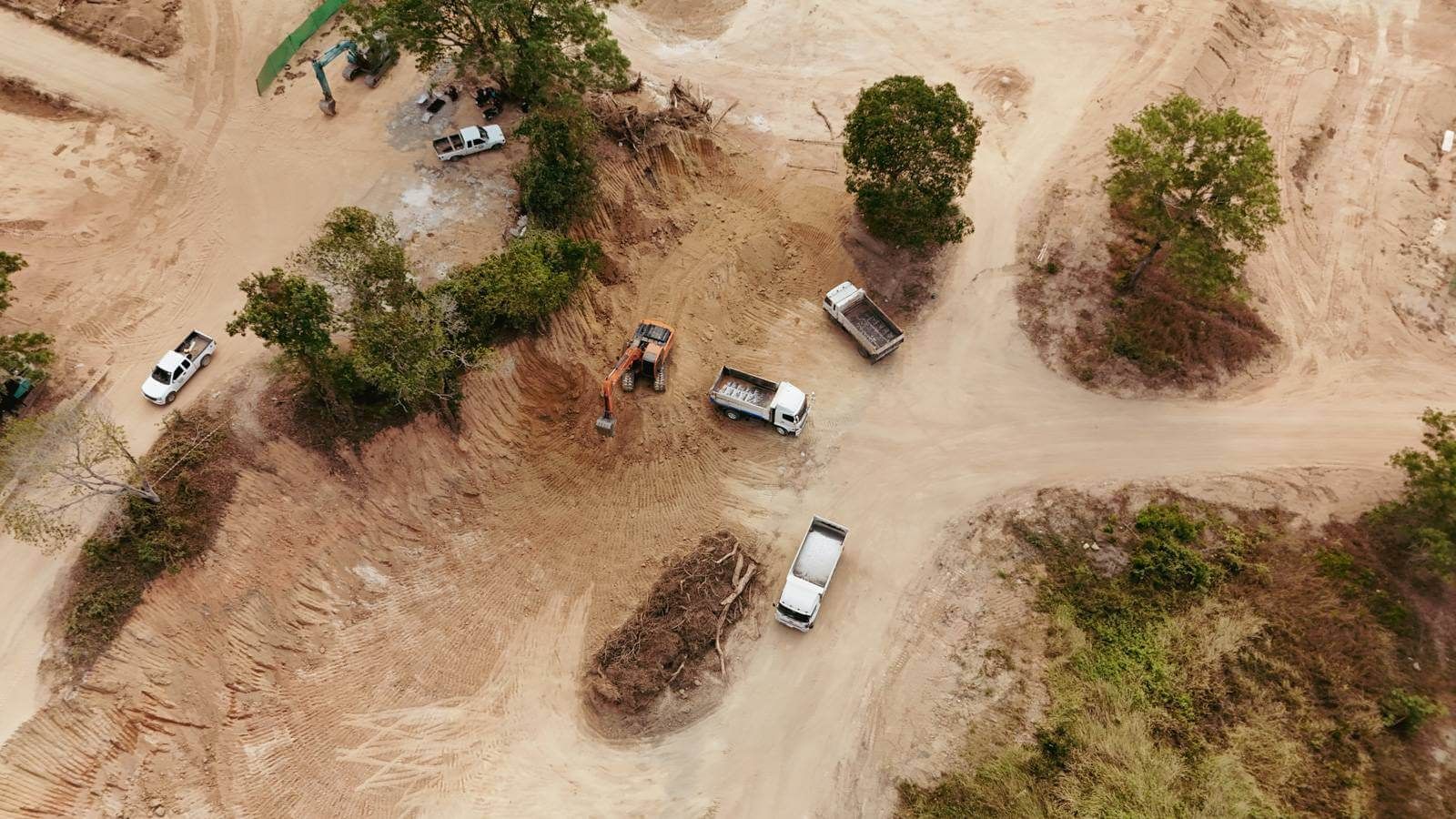

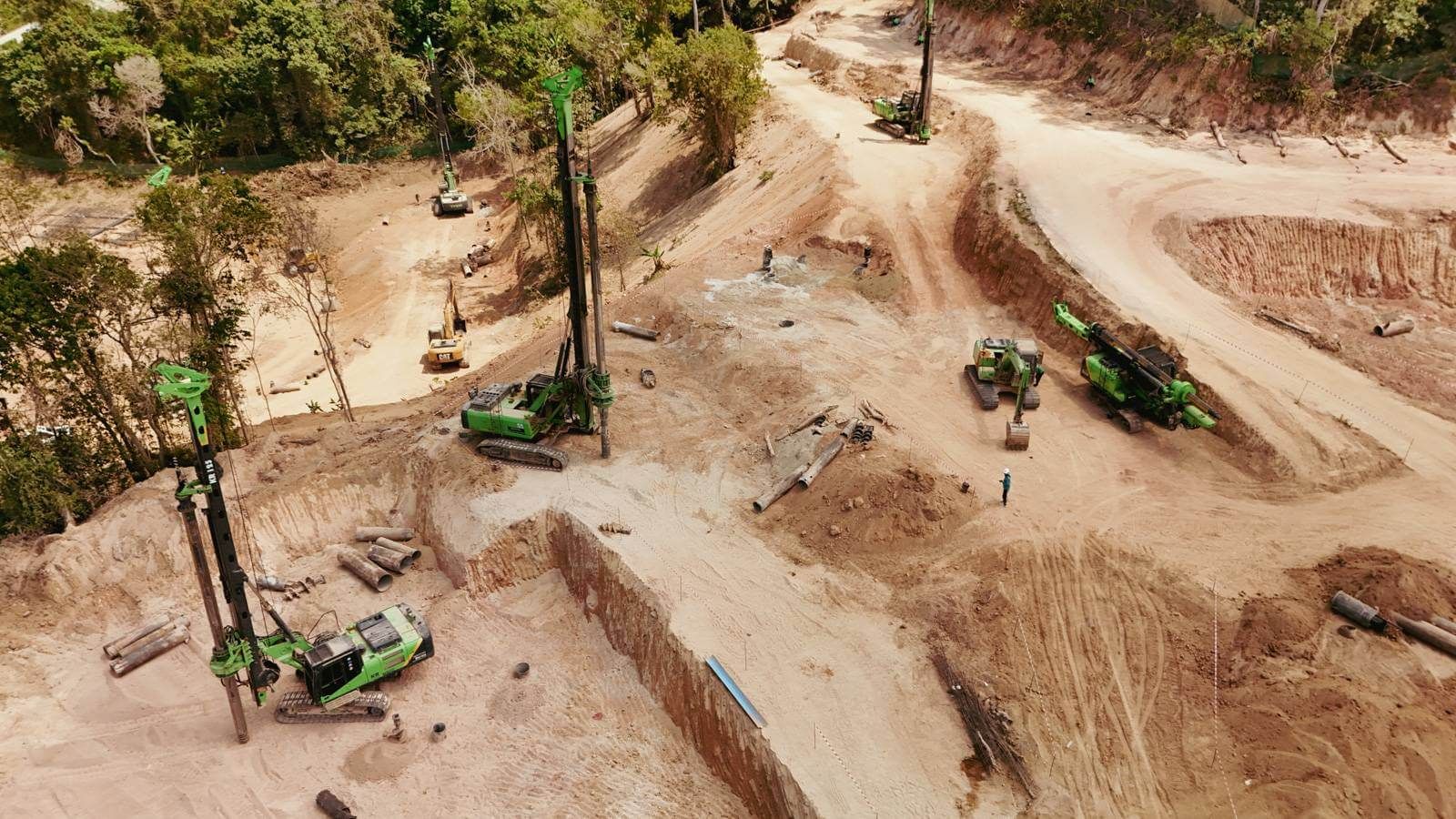

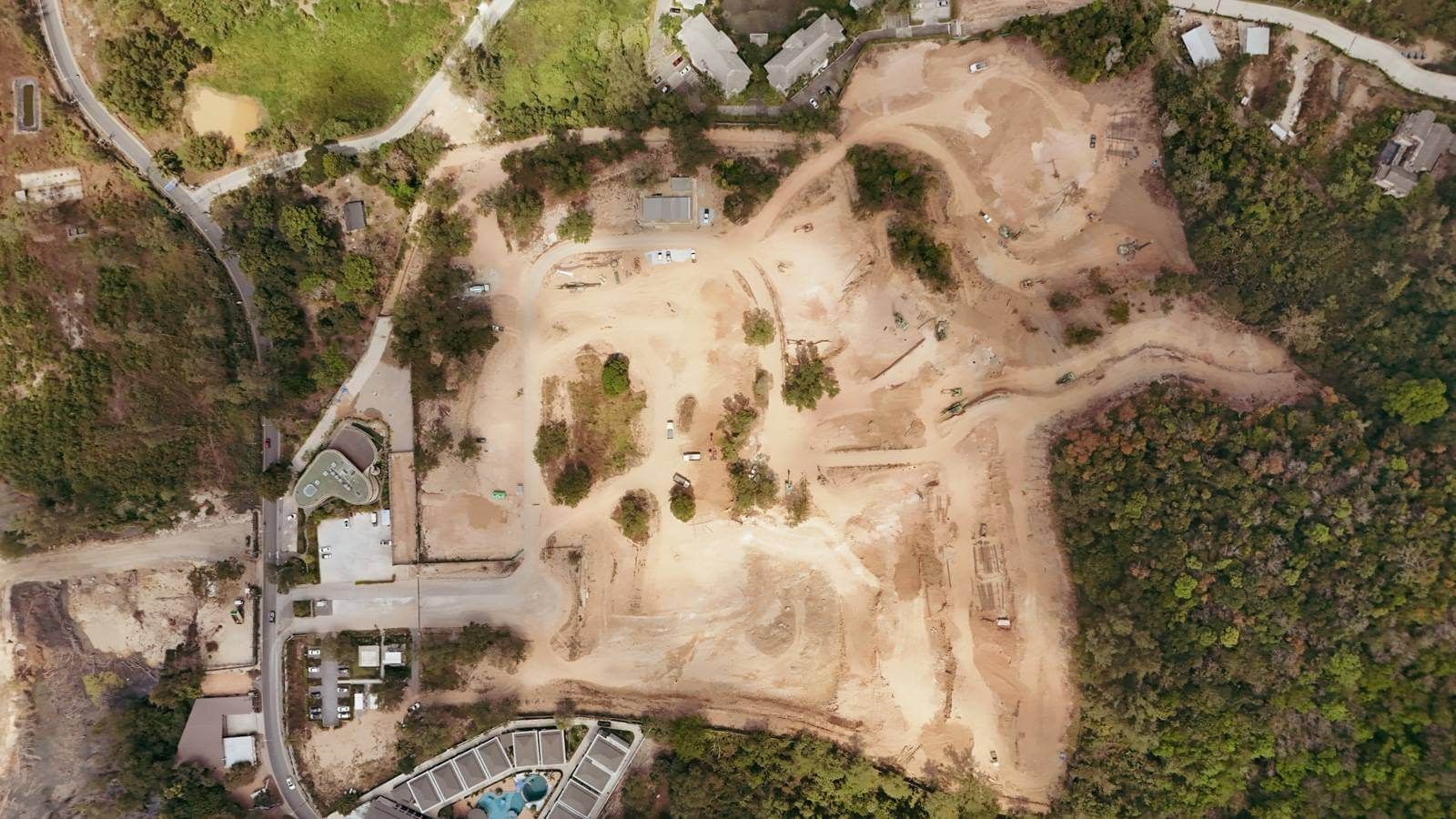

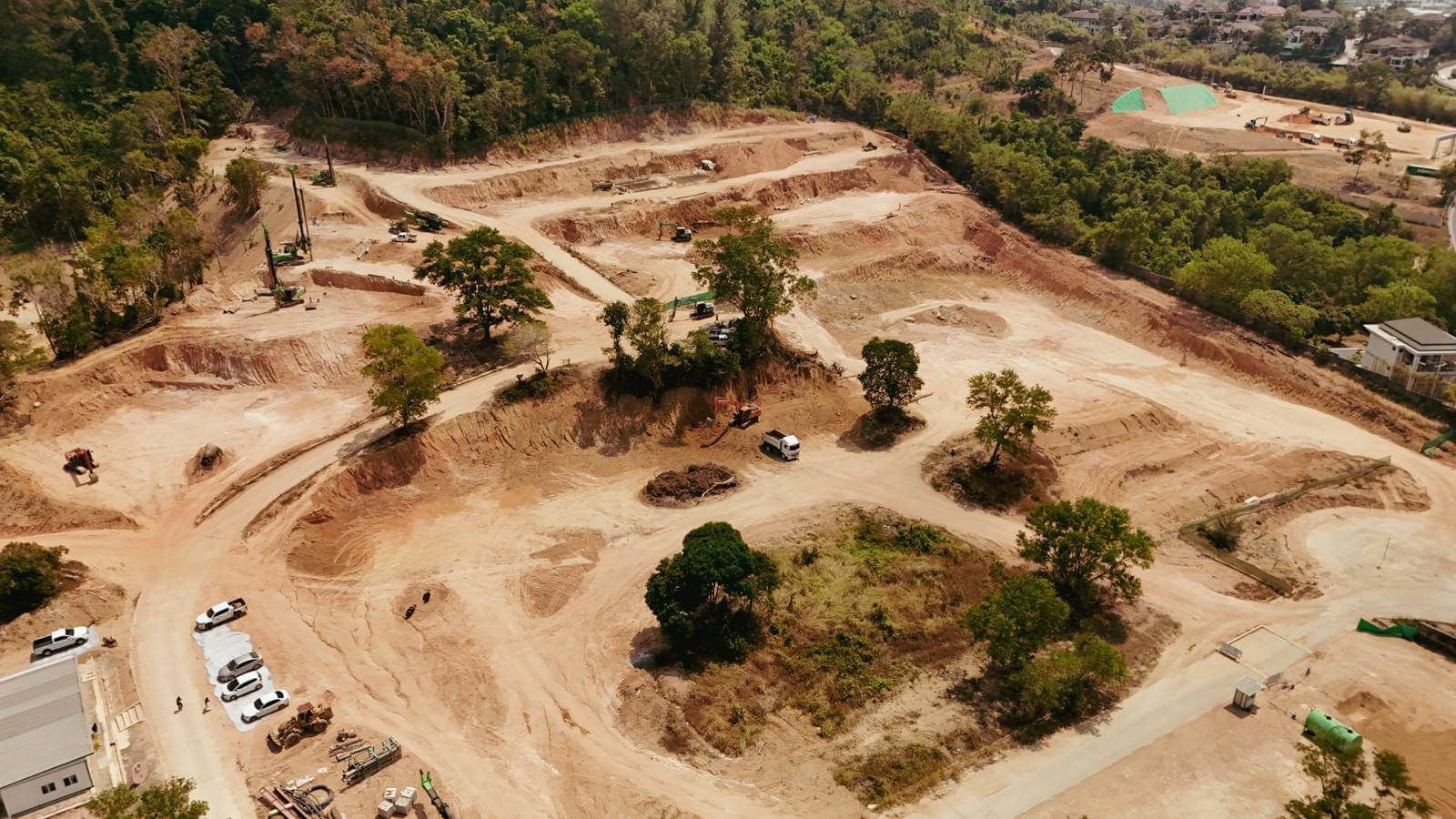

Installed 1026 piles. The installation of the A4 building is 91% complete. The excavation of the soil for Phase 1A has been completed by 95% of the total volume, with 66,020 m³ removed. Active excavation work for Phase 2 is underway, with 11,367 m³ of soil removed.
