July 17, 2025
6 photo

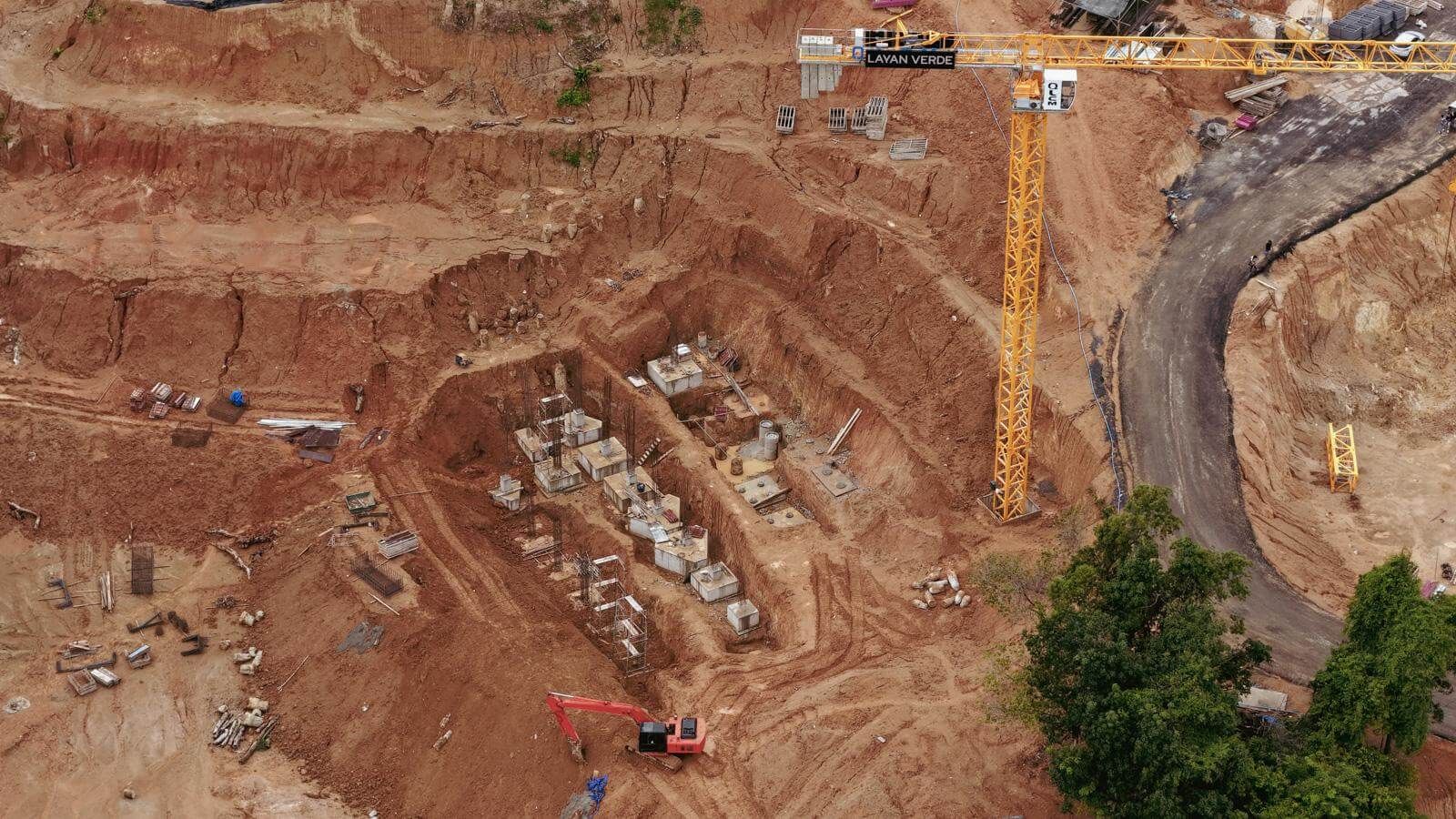

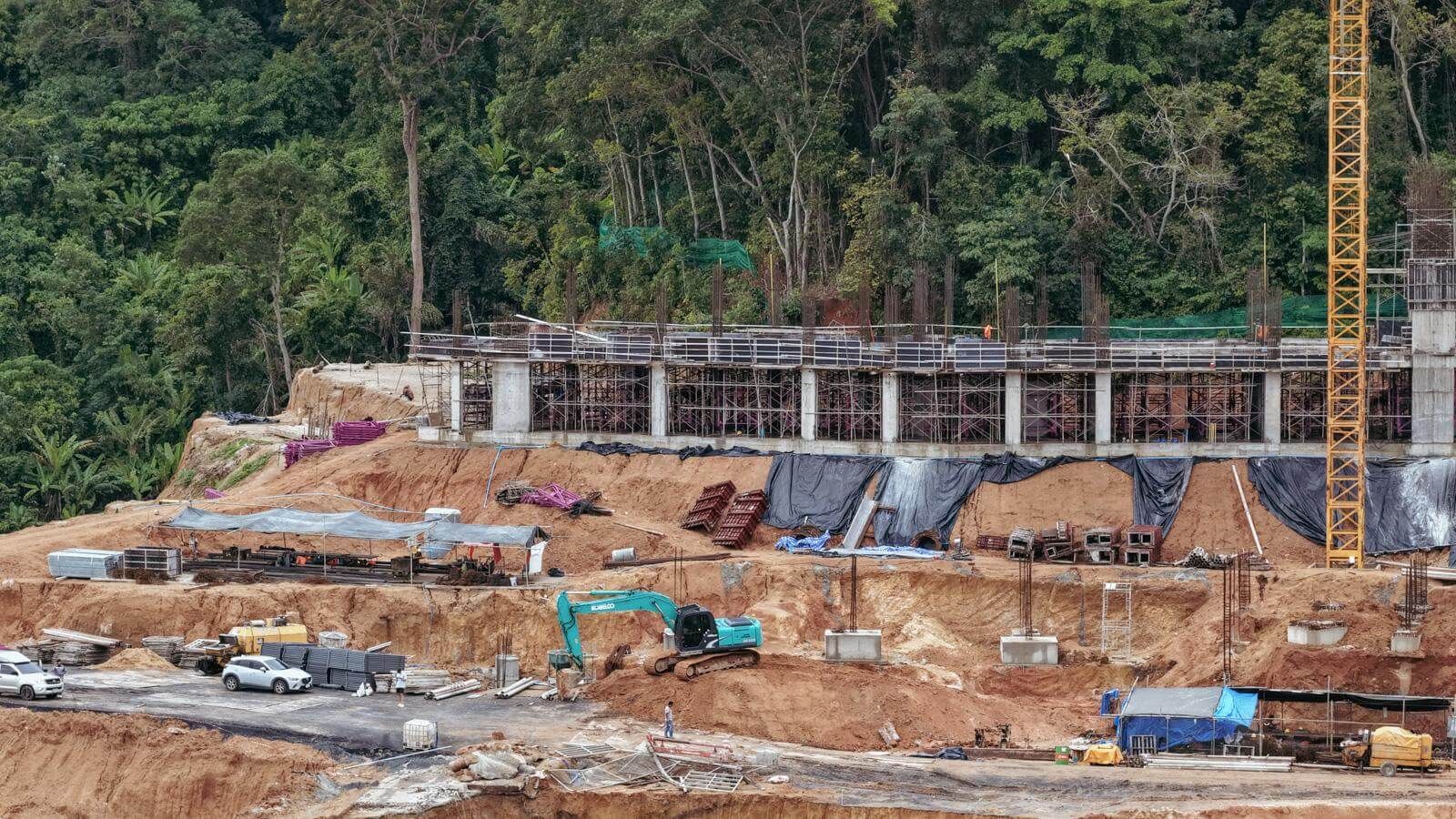

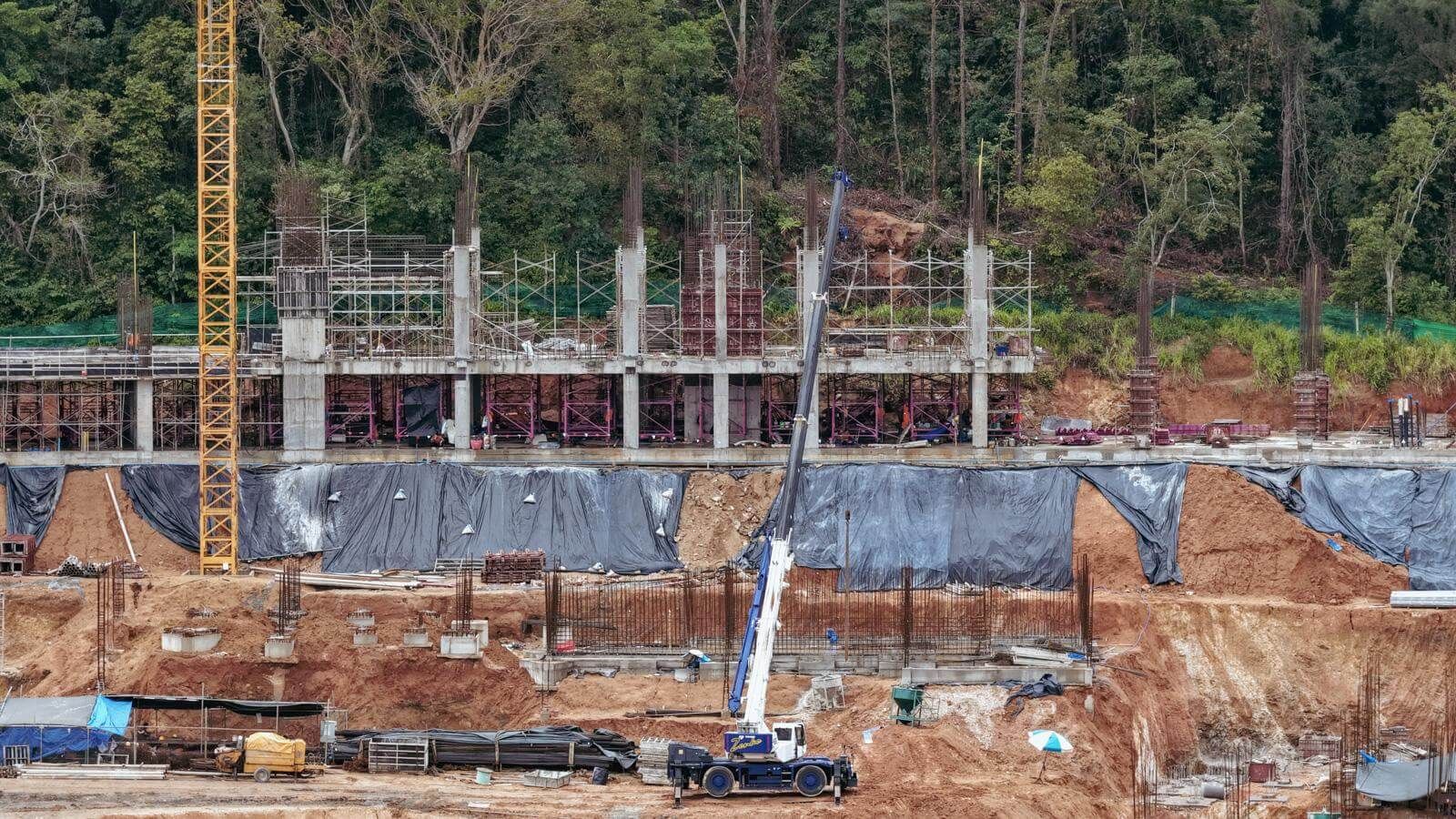

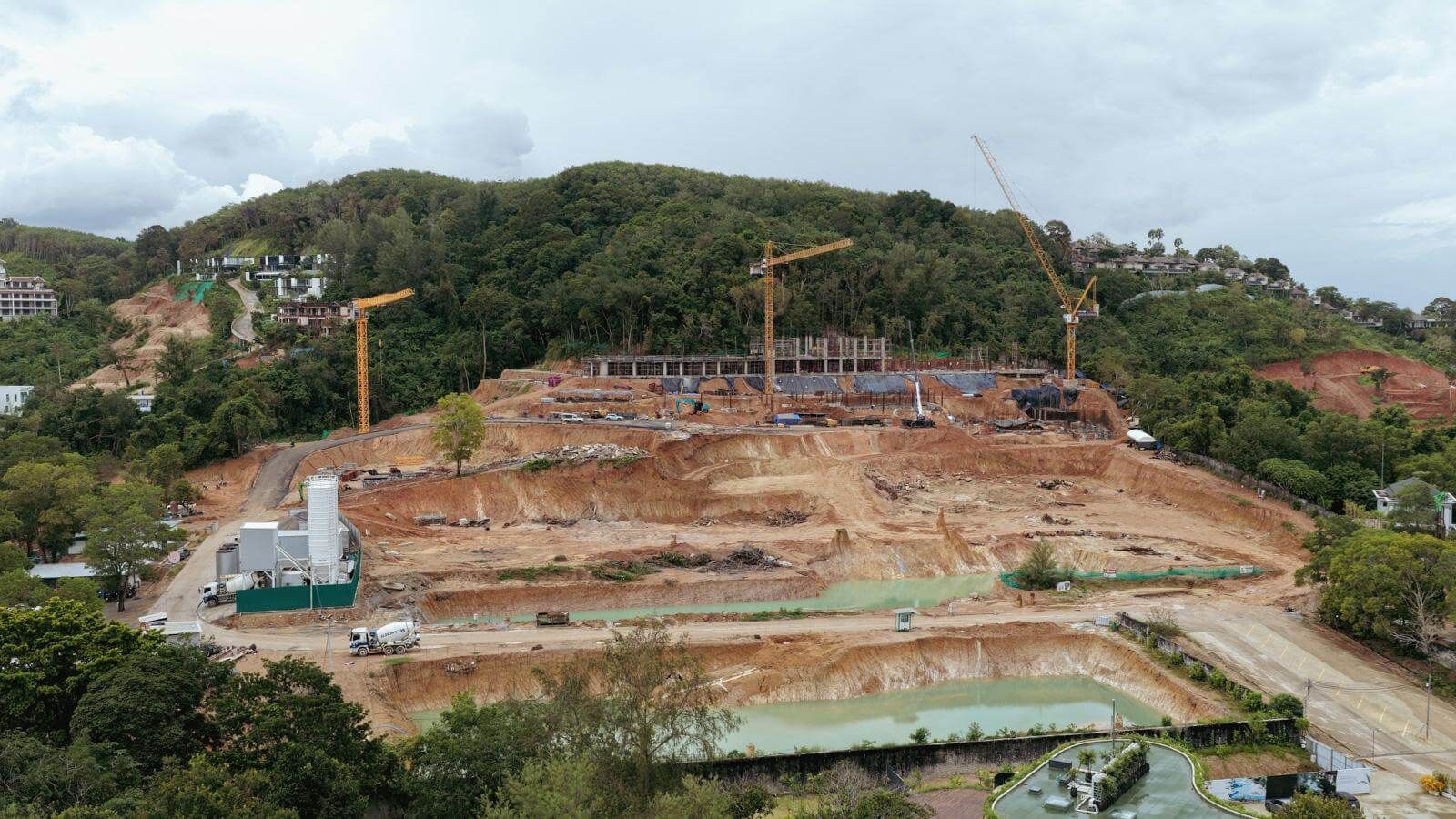

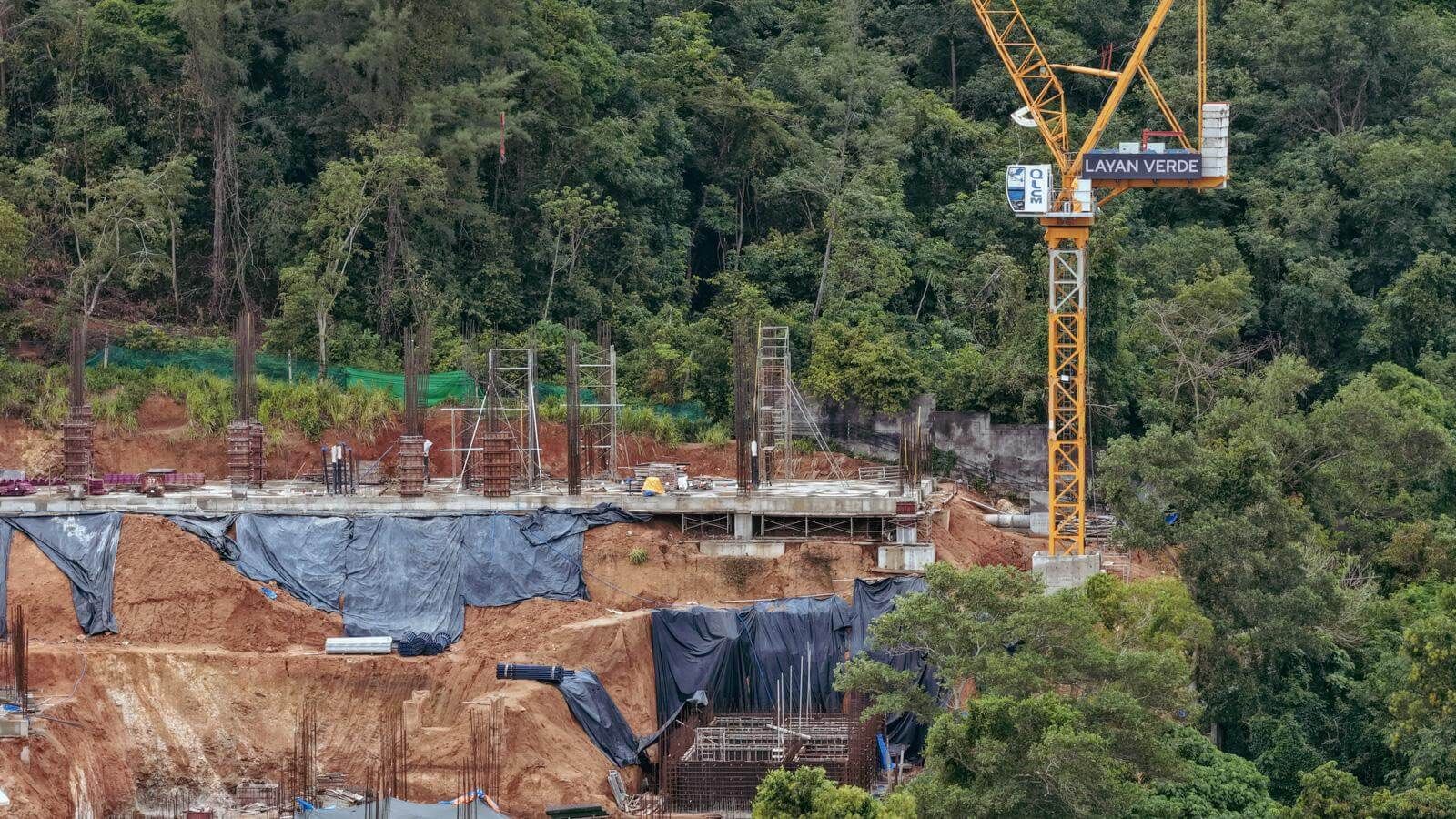

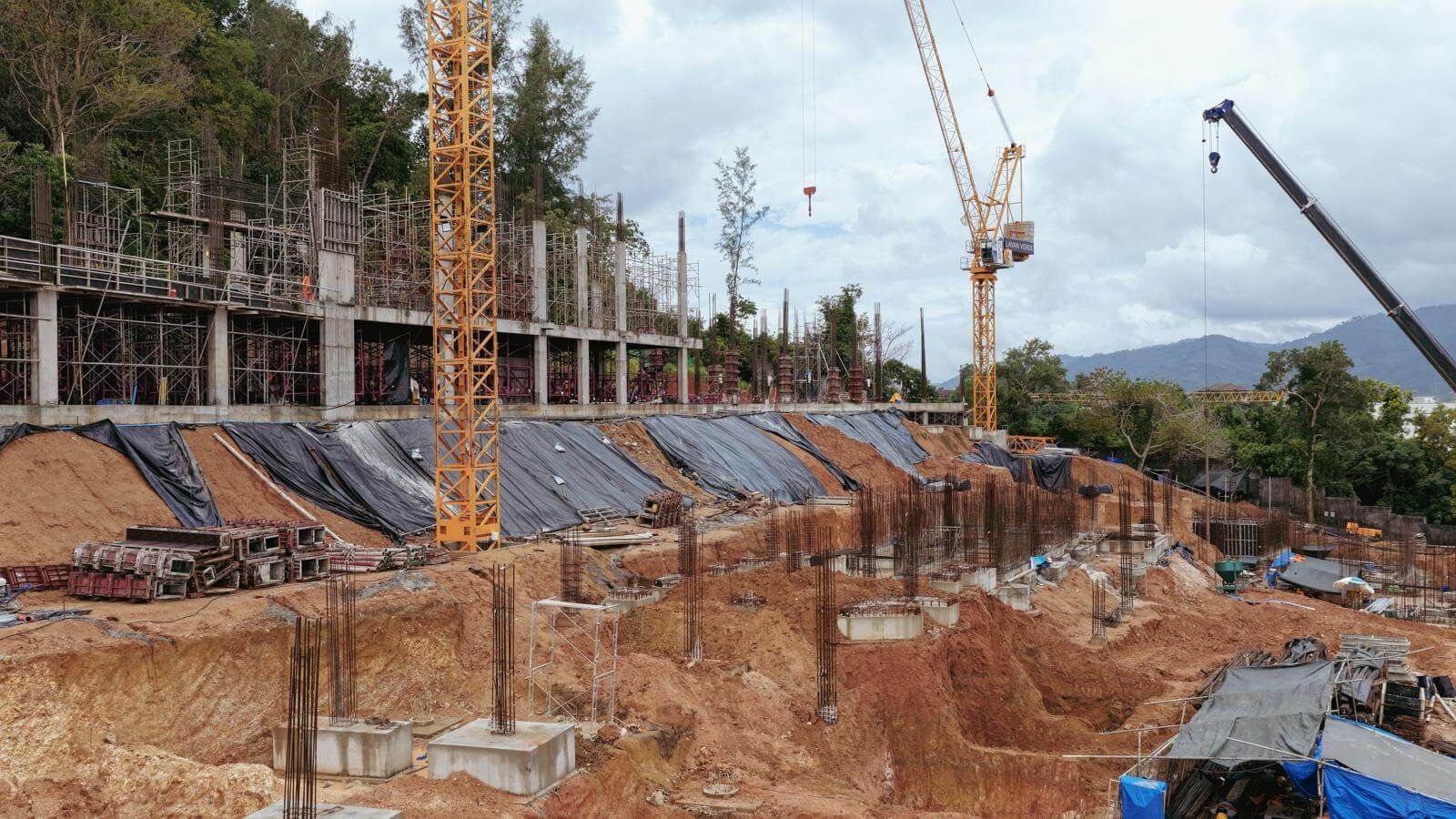

As of the reporting date, a total of 188,620 m³ of soil has been excavated and 2,226 m³ of concrete has been cast. Significant progress has been made on Building A5: In Zone 1, formwork and reinforcement installation for the second floor is ongoing; In Zone 2, formwork installation for the third floor is in progress; In Zone 3, the first-floor slab has been cast, and column installation has commenced. Foundation and structural works for the water storage tanks are underway for both Buildings A2.1 and A2.2. At Building A3.1, pile head trimming and foundation construction are in progress. Earthworks continue in the areas of Buildings BM1 and BM2.
