November 29, 2025

5 photo

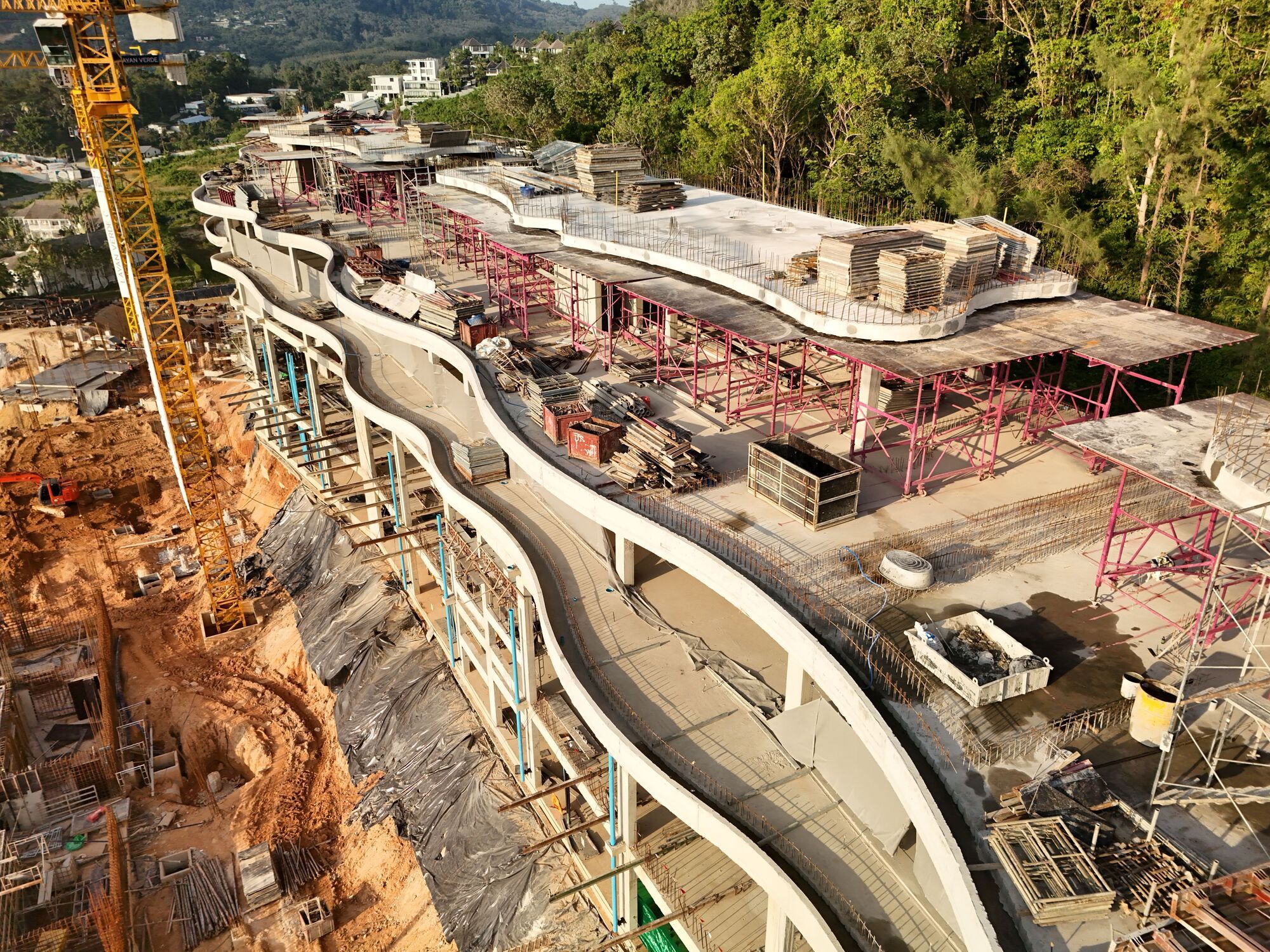

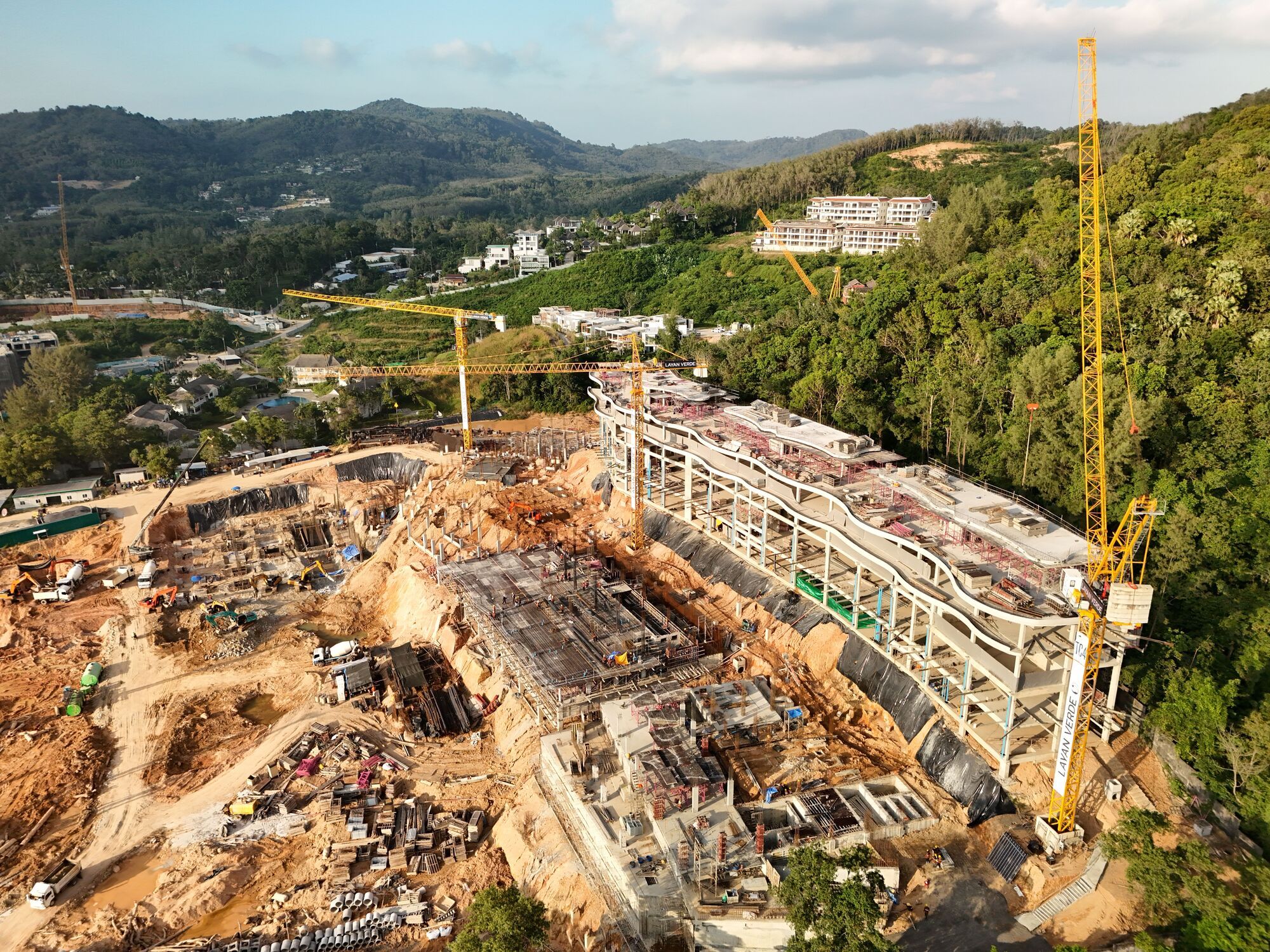

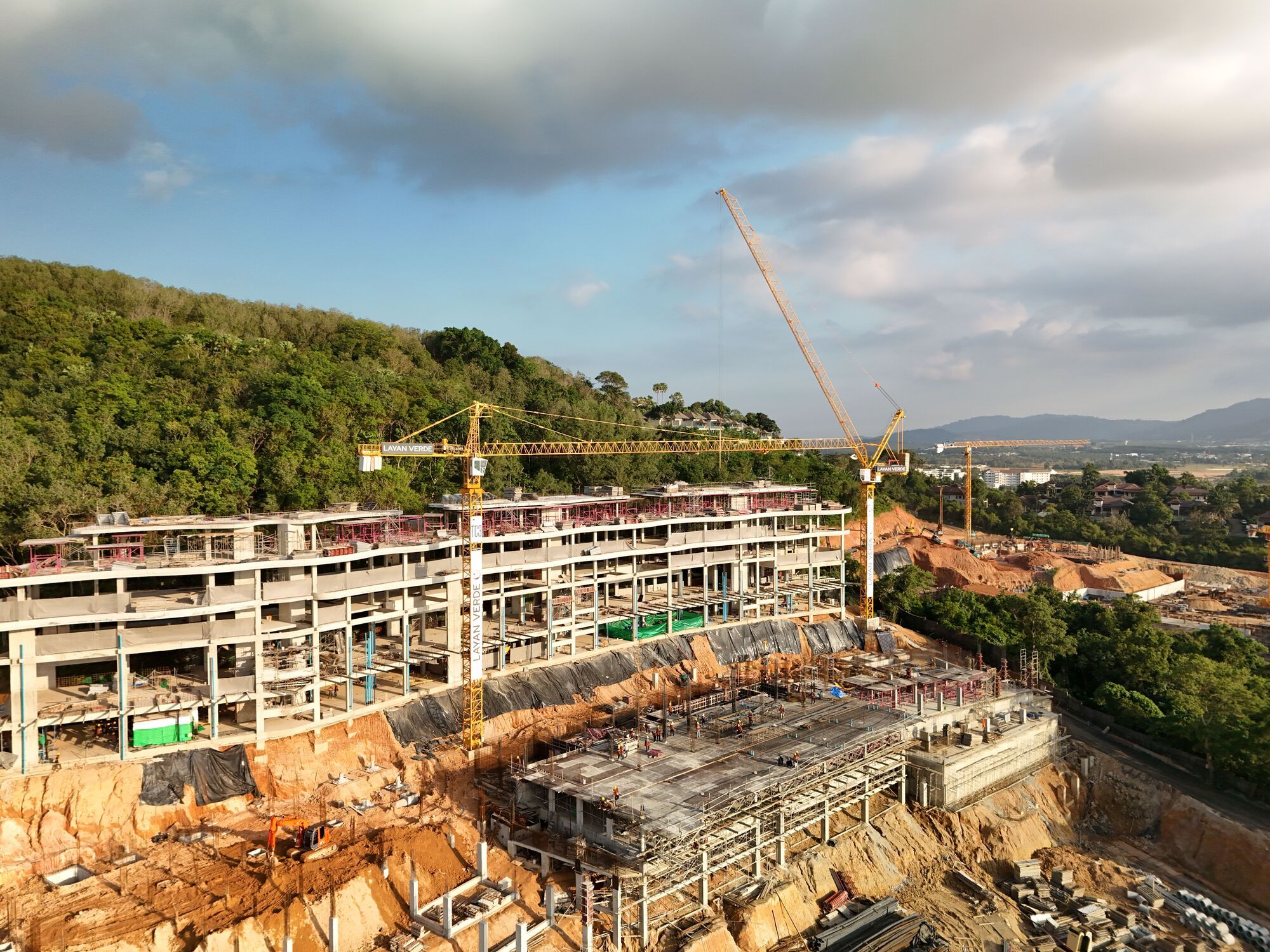

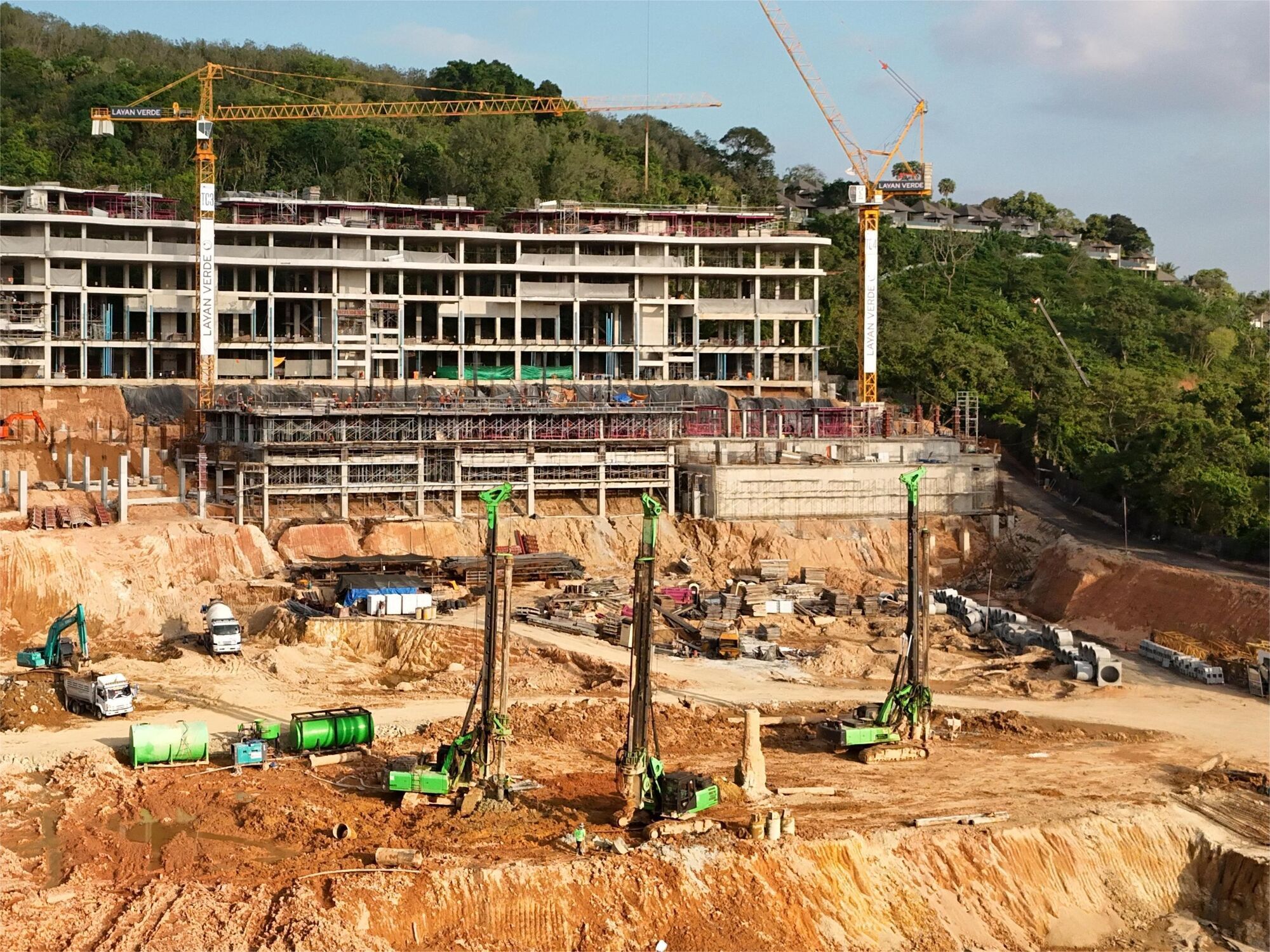

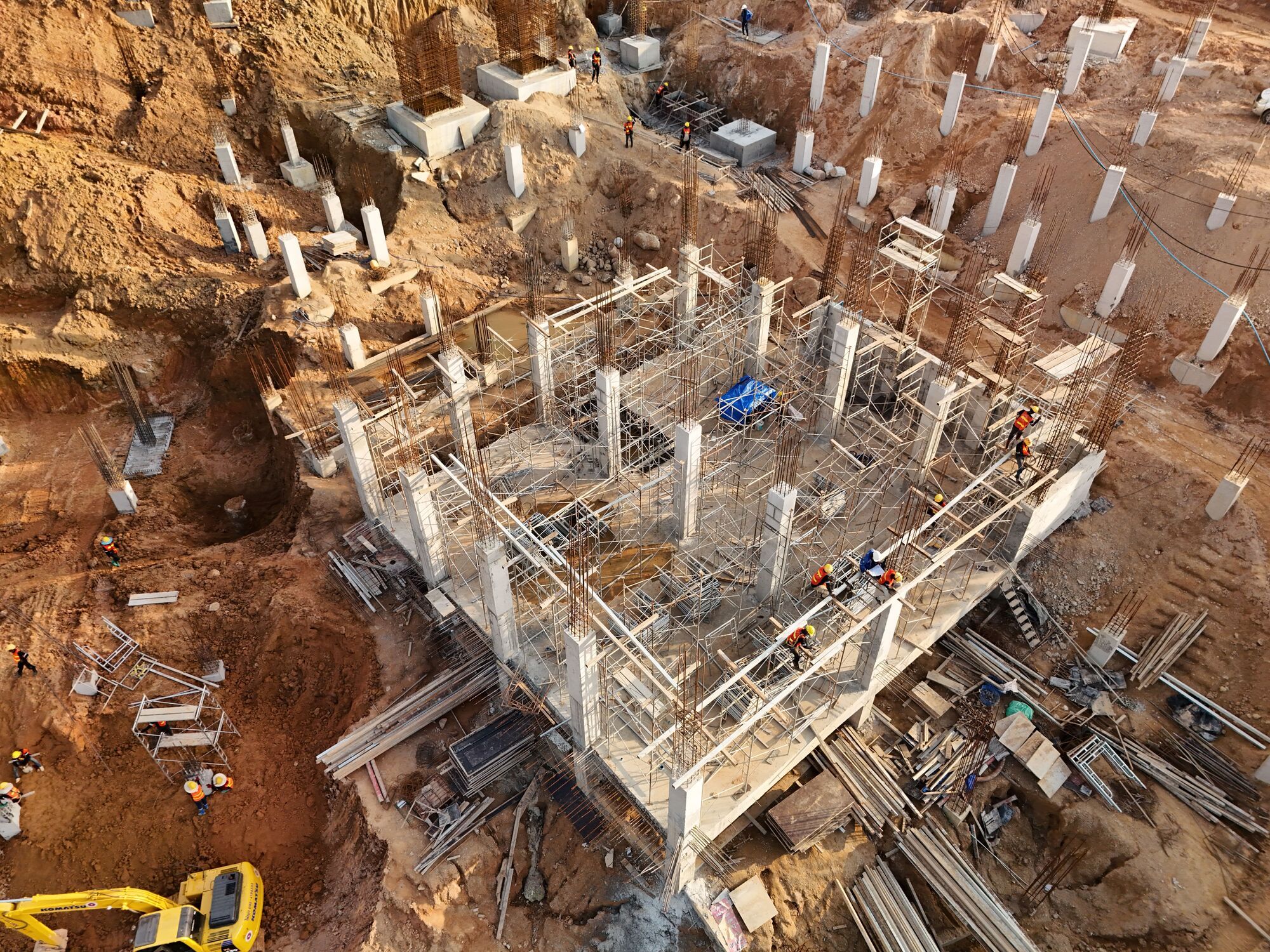

The total volume of placed structural concrete is 6,573 m³. In Zones 1, 2, and 3 of Building A5, the roof slab is cast, and installation and testing of the passenger elevator are in progress. In Buildings A2.1 and A2.2, construction of the foundation and water reservoirs is nearly complete, and first-floor slab works are underway. Foundation works continue for Buildings A3.1 and A4. Pile installation for Building B9 is progressing.
