November 19, 2025
8 photo

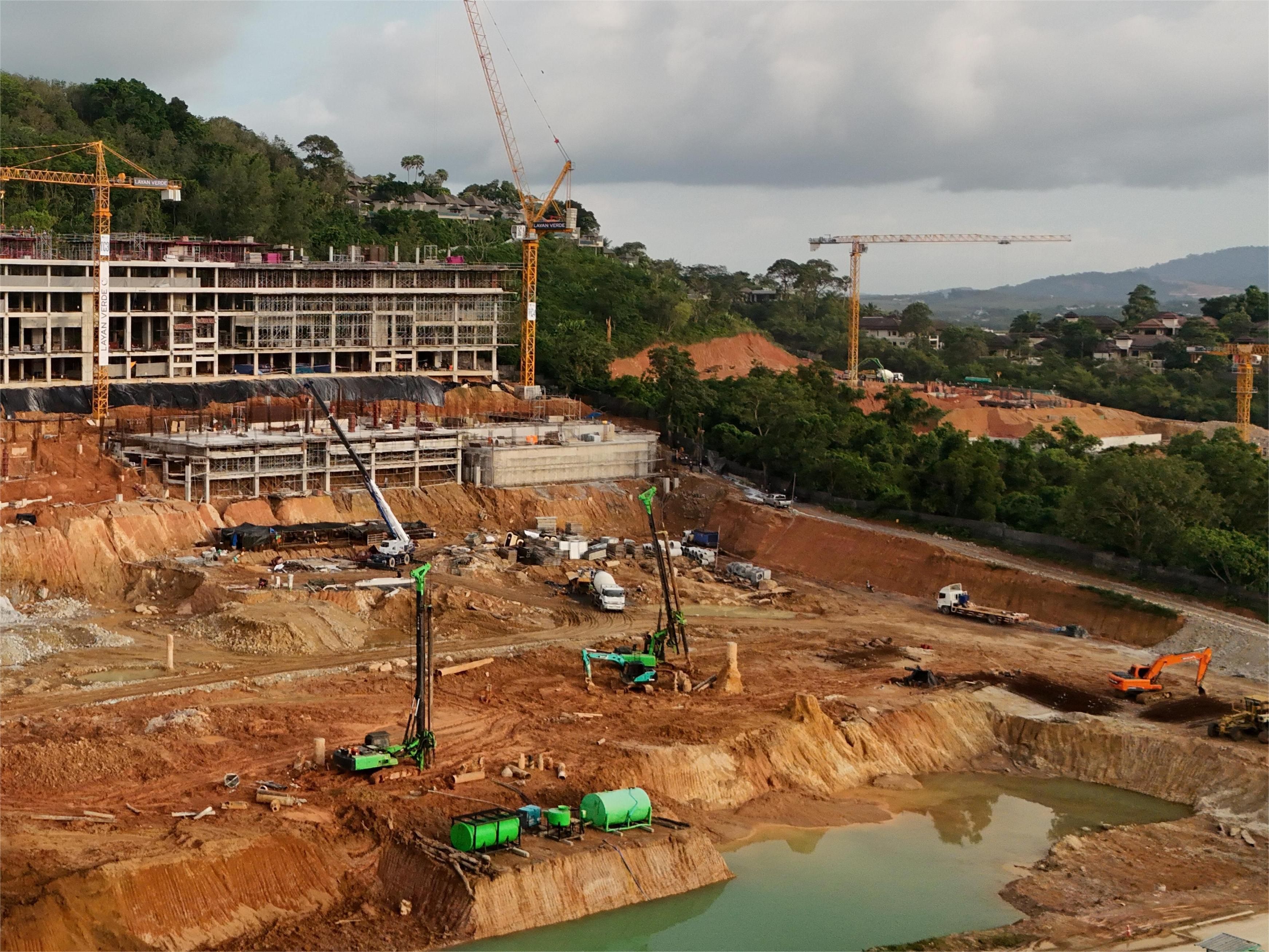

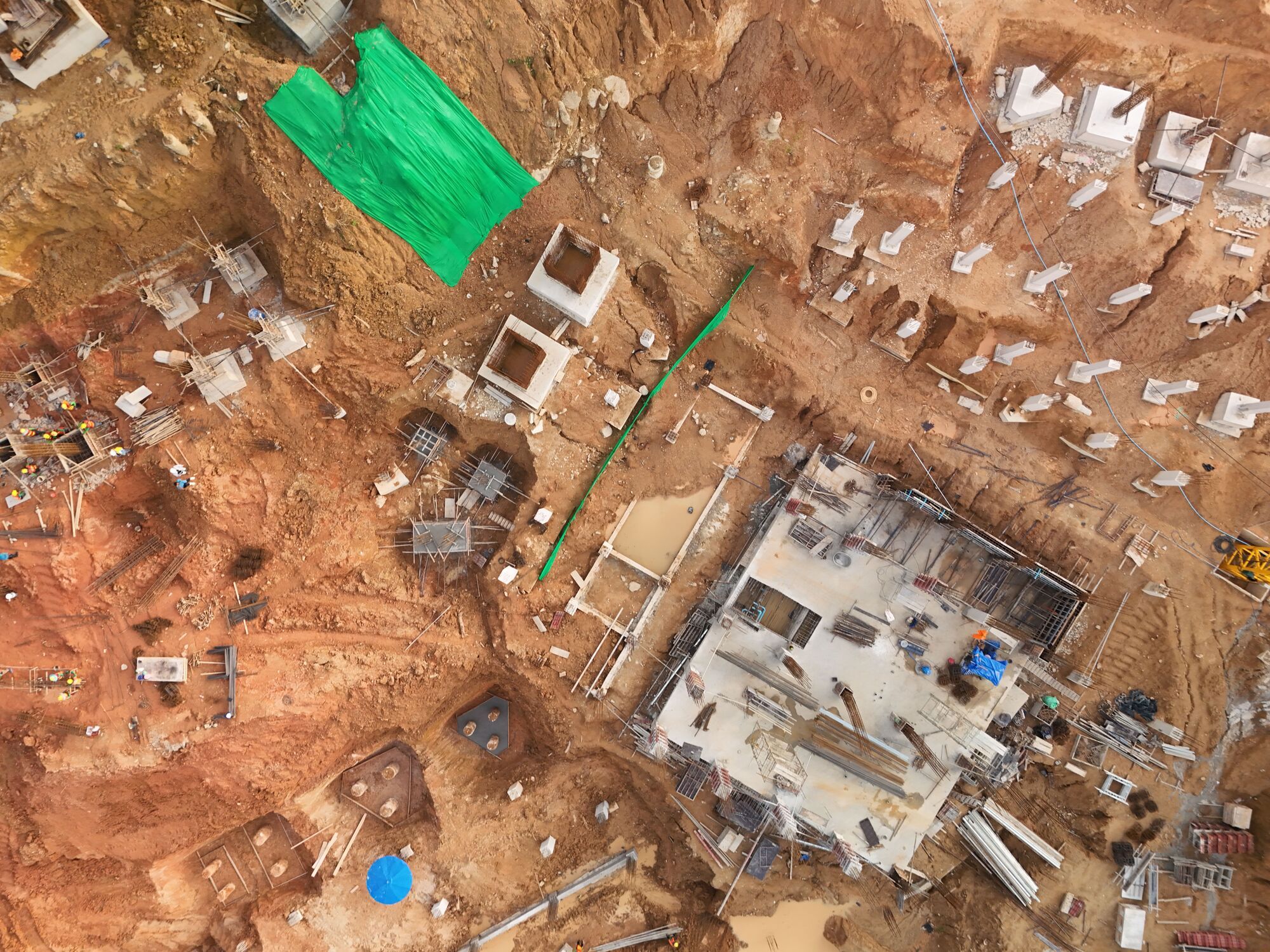

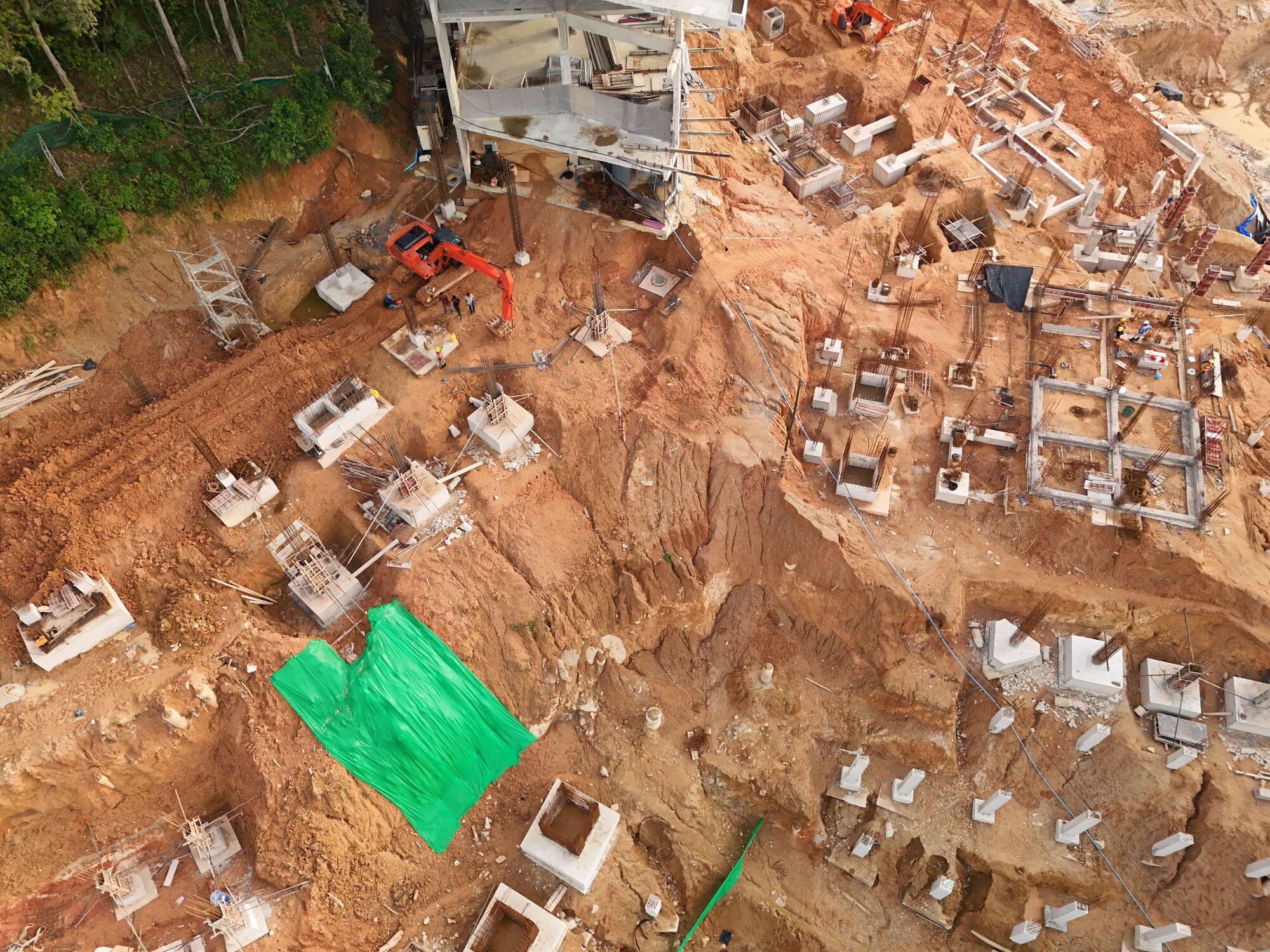

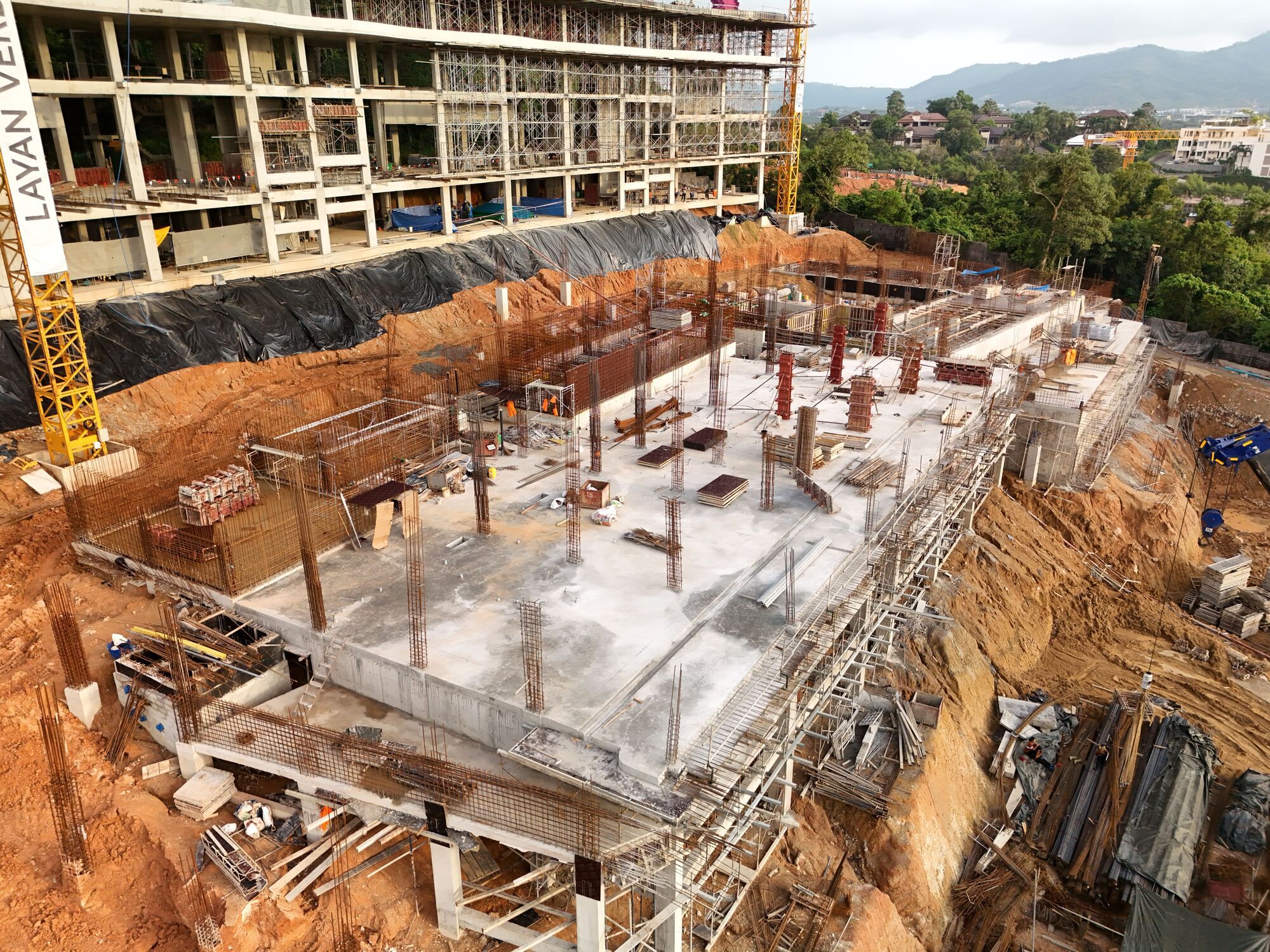

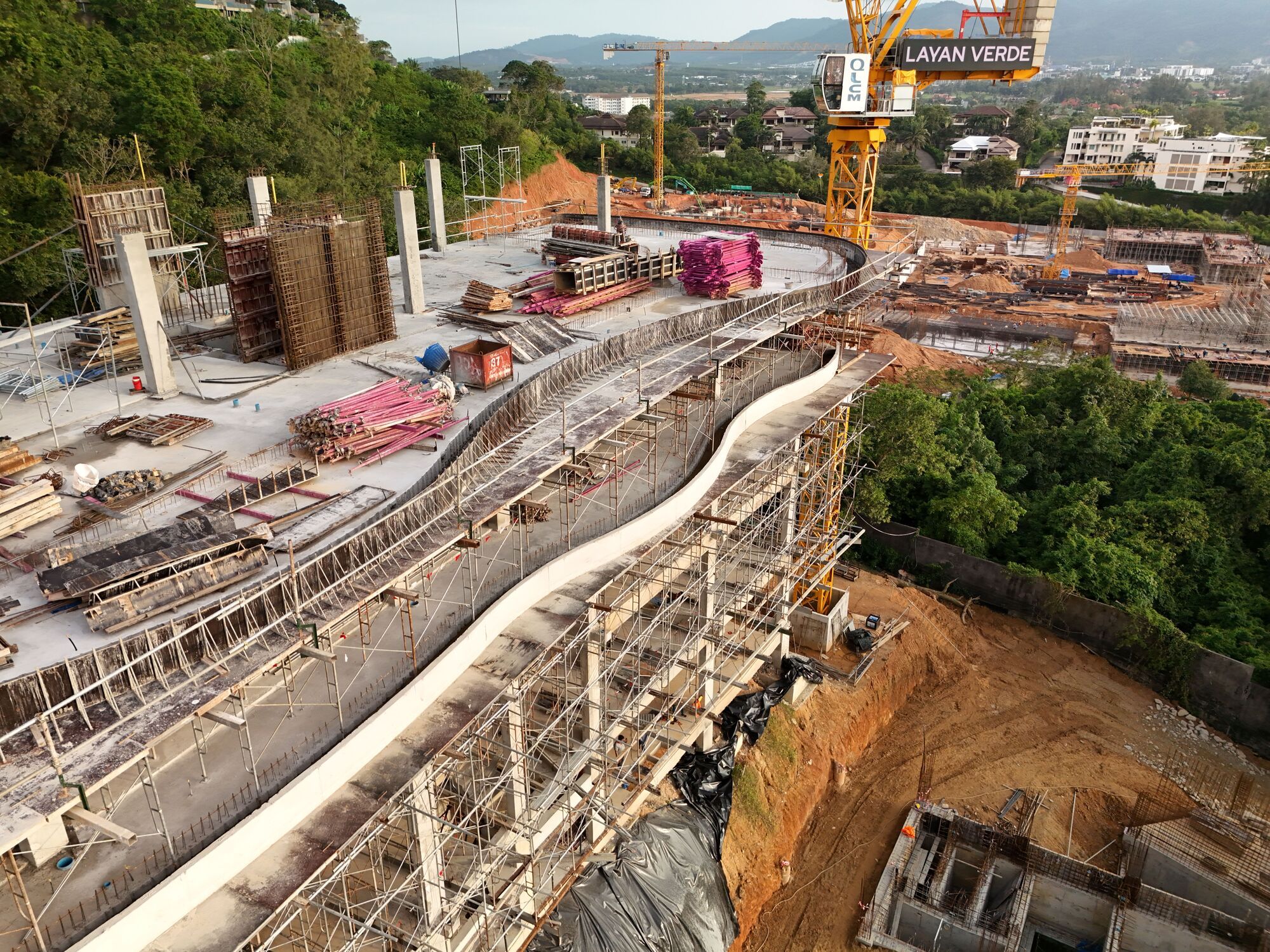

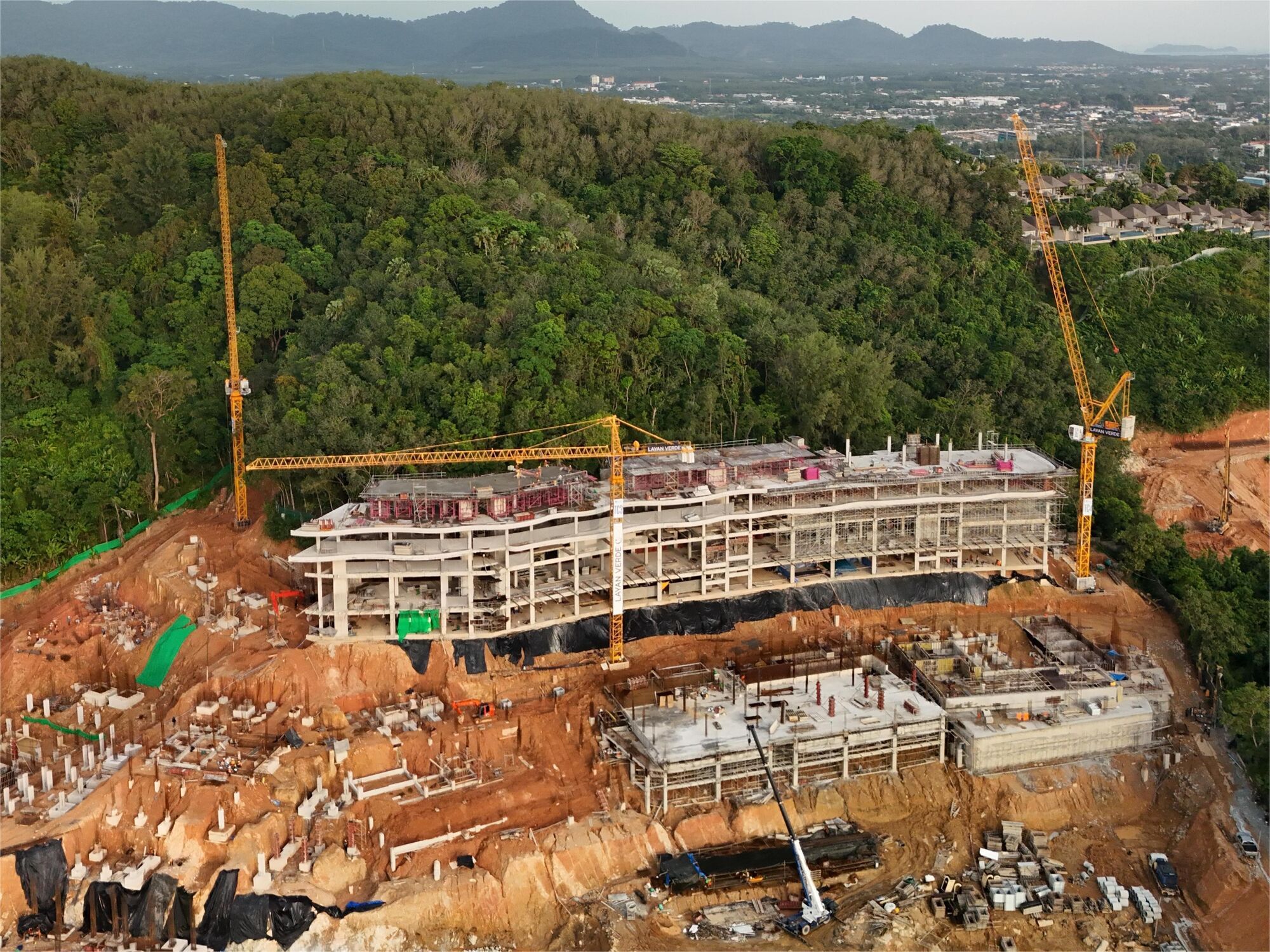

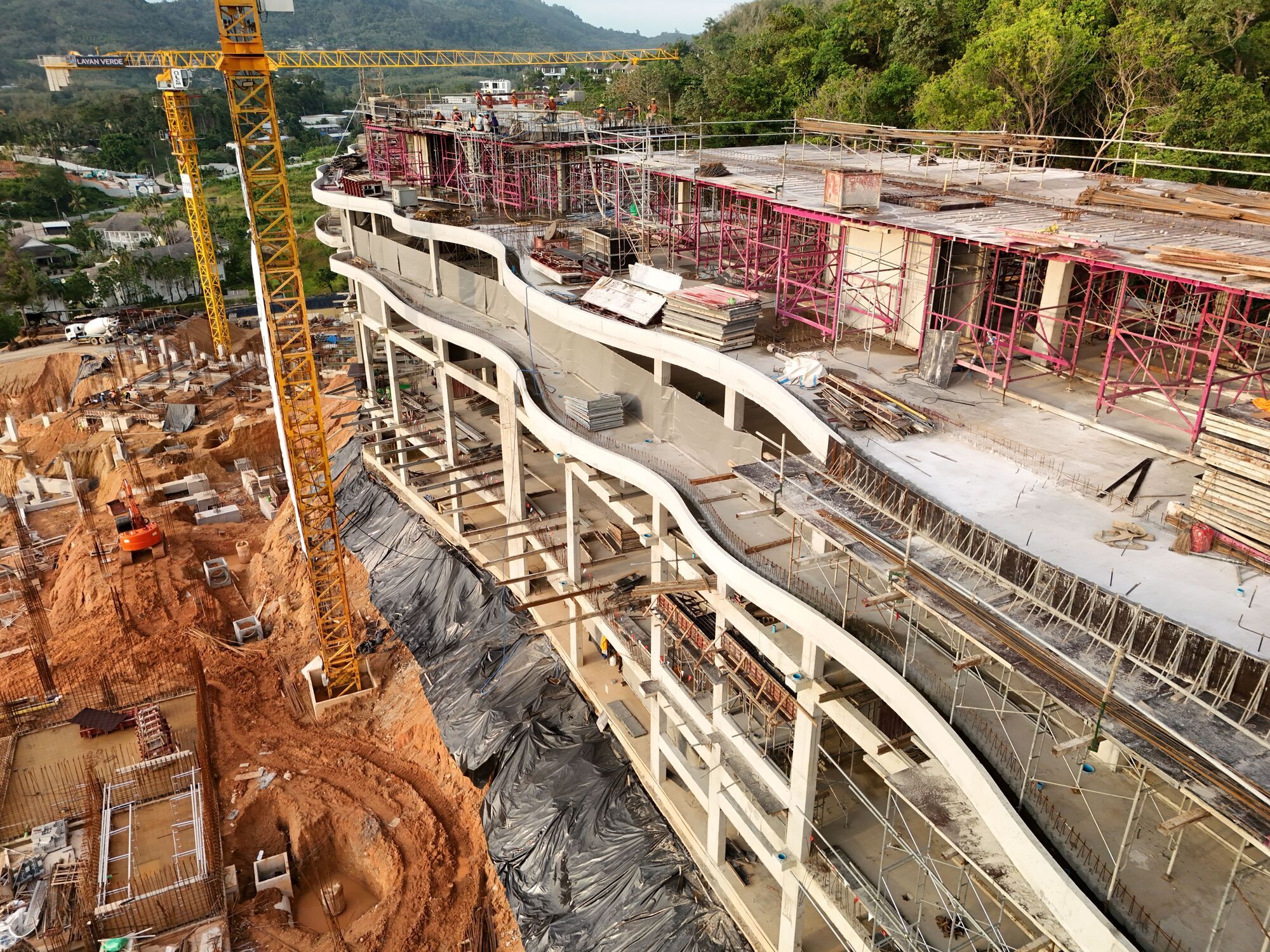

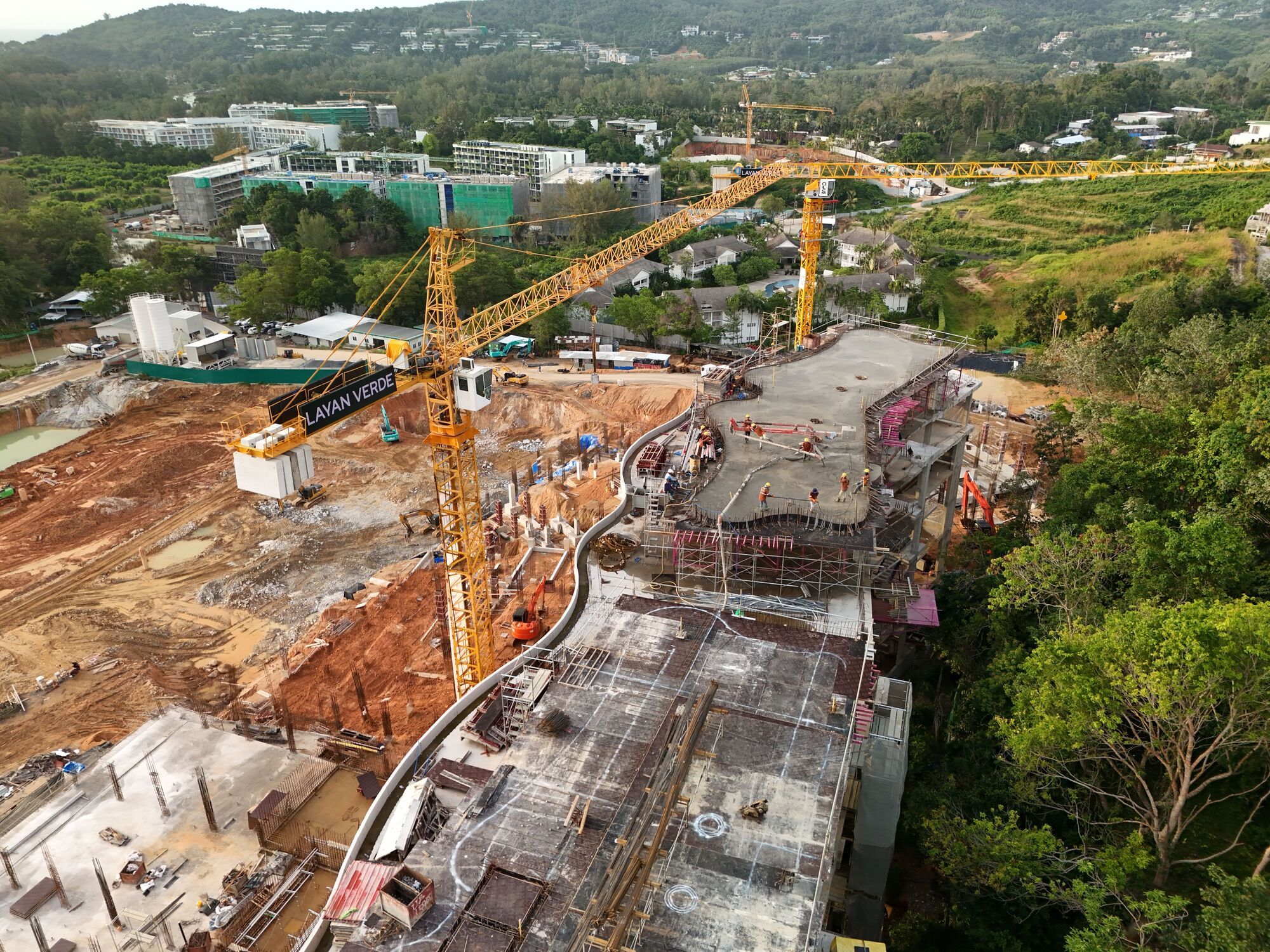

A total of 1,701 piles are installed at the Layan Verde construction site. Earth excavation works continue, with 240,540 m³ of soil removed to date. In Building A5, casting of the 5th-floor roof slab in Zone 1 is complete; column construction for the 5th-floor roof slab continues in Zone 2; post-tensioning of the 5th-floor slab is in progress in Zone 3. Waterproofing of the foundations for Buildings A2.1 and A2.2 continues. Foundation works for Buildings A3.1 and A4 are ongoing. Pile installation for Building B8 is complete, and pile installation for Building B9 is in progress. A total of 5,790 m³ of concrete has been placed for foundations and structural frame elements.
