December 29, 2025
7 photo

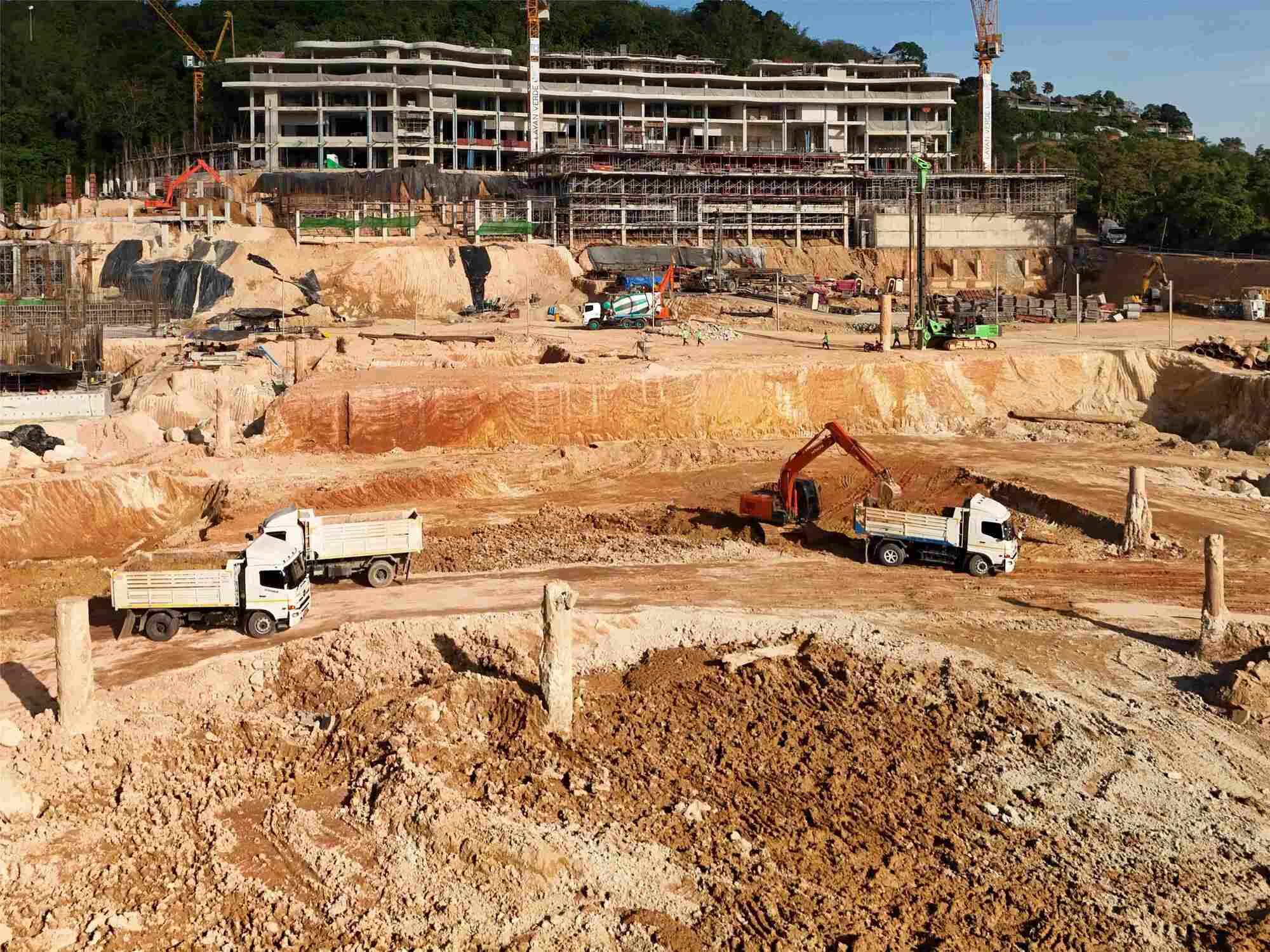

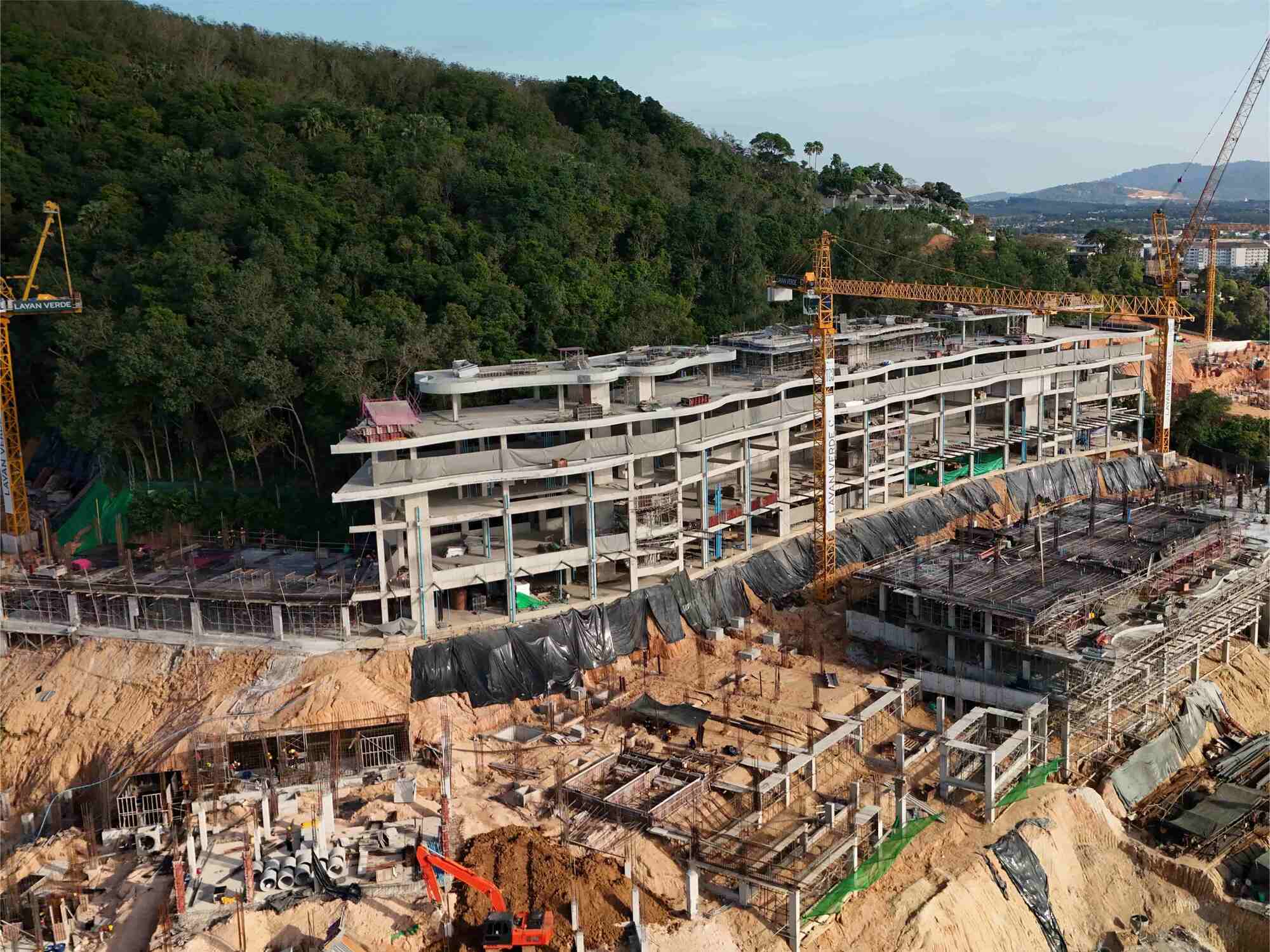

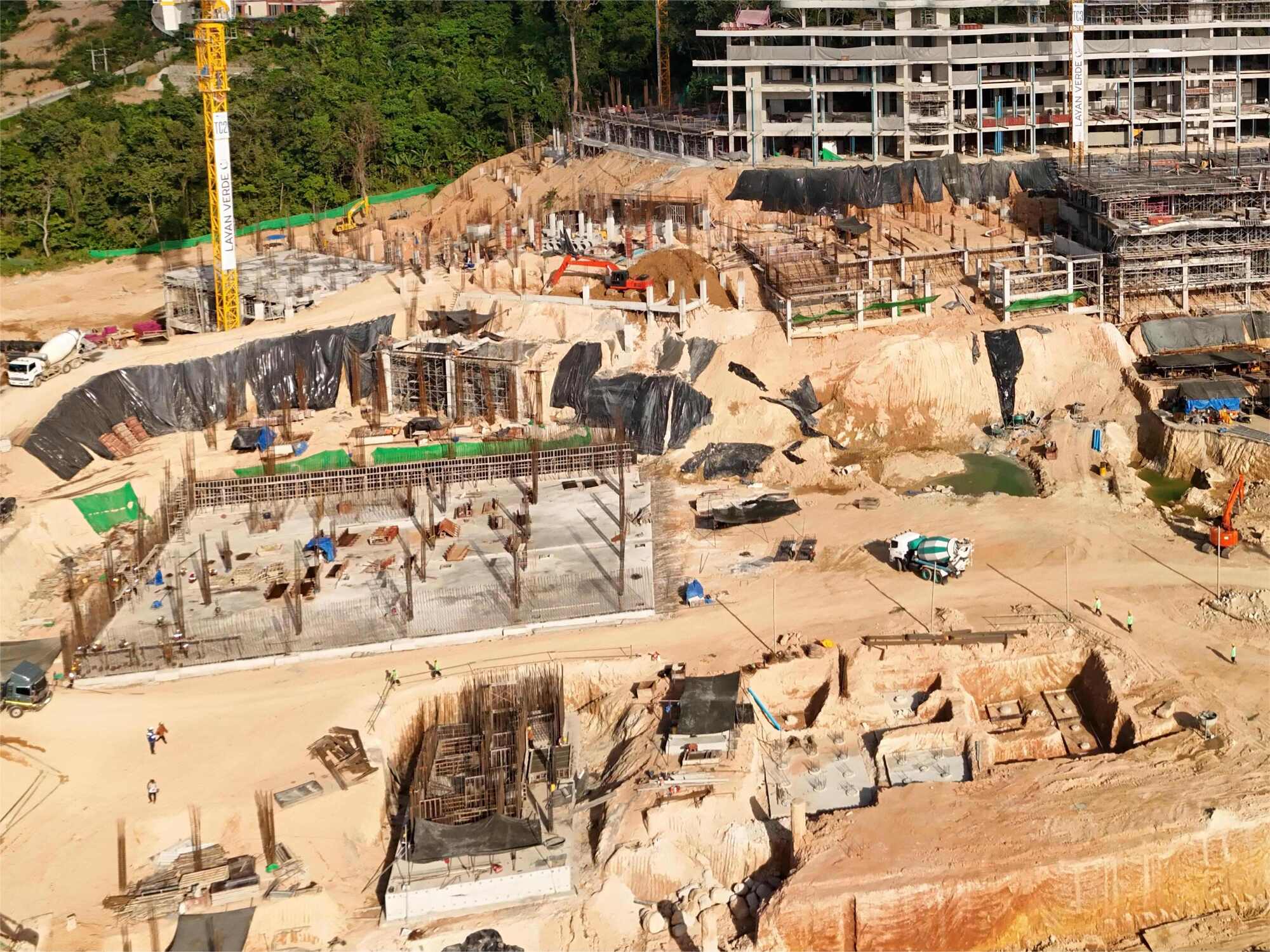

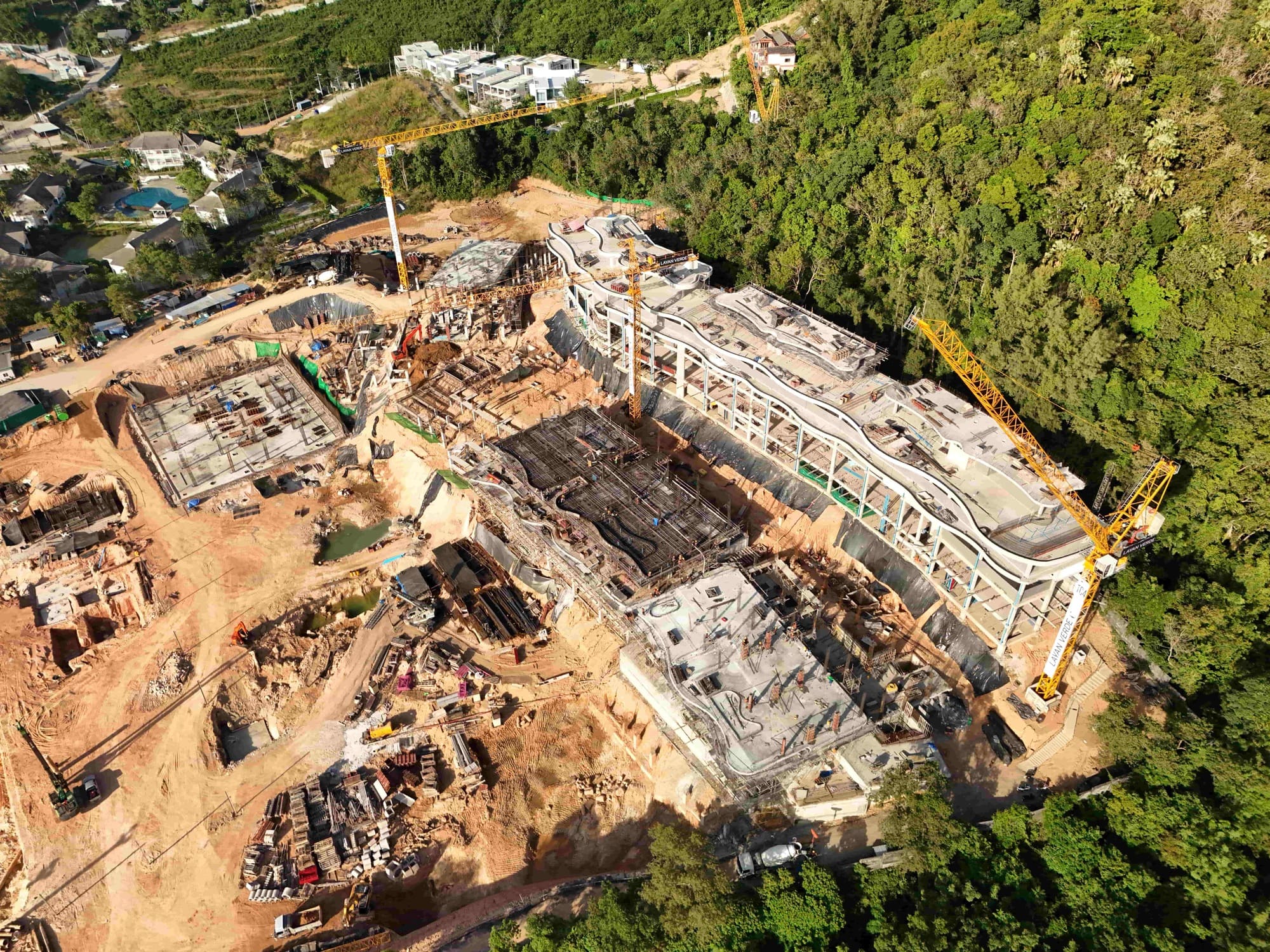

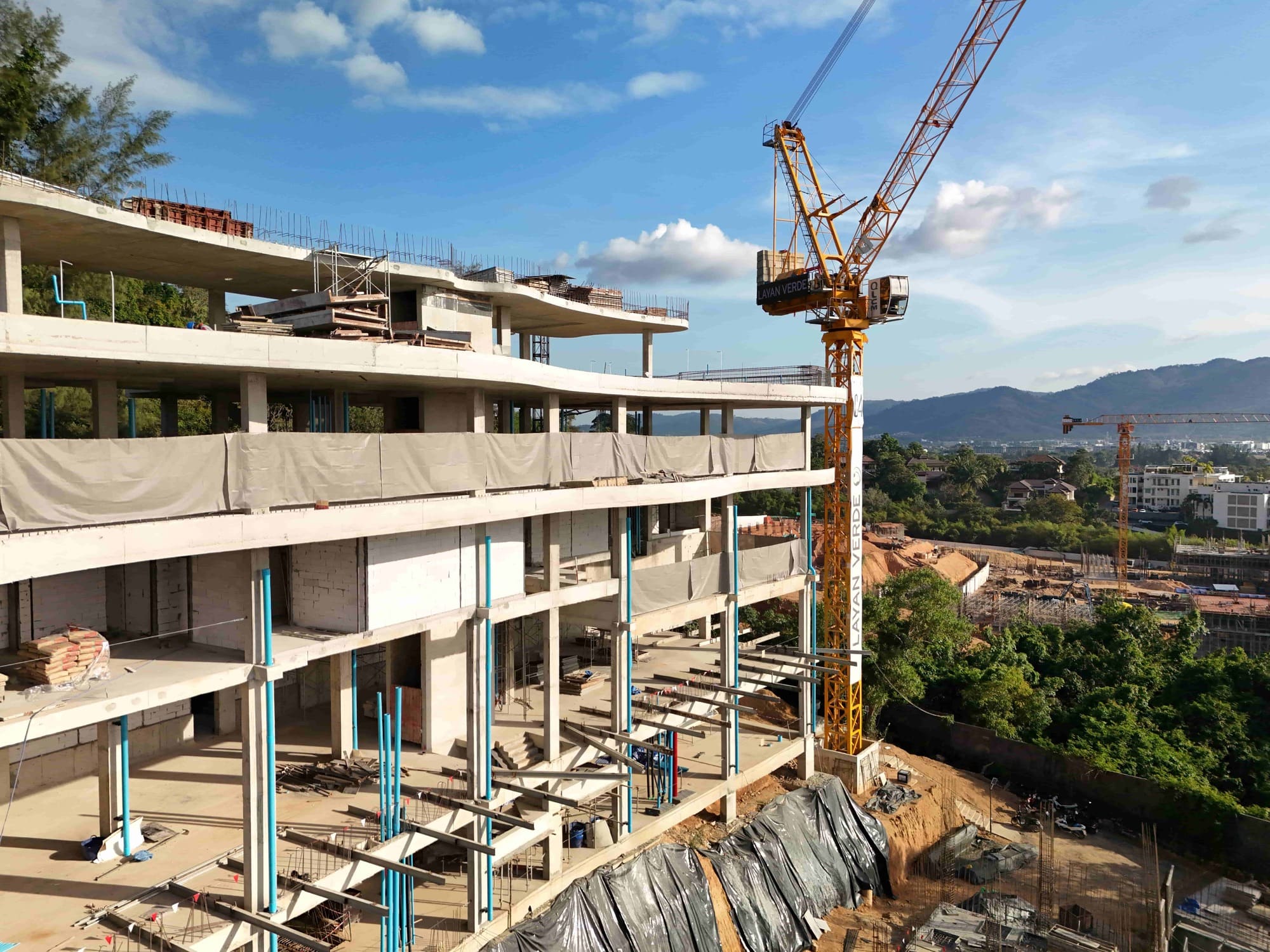

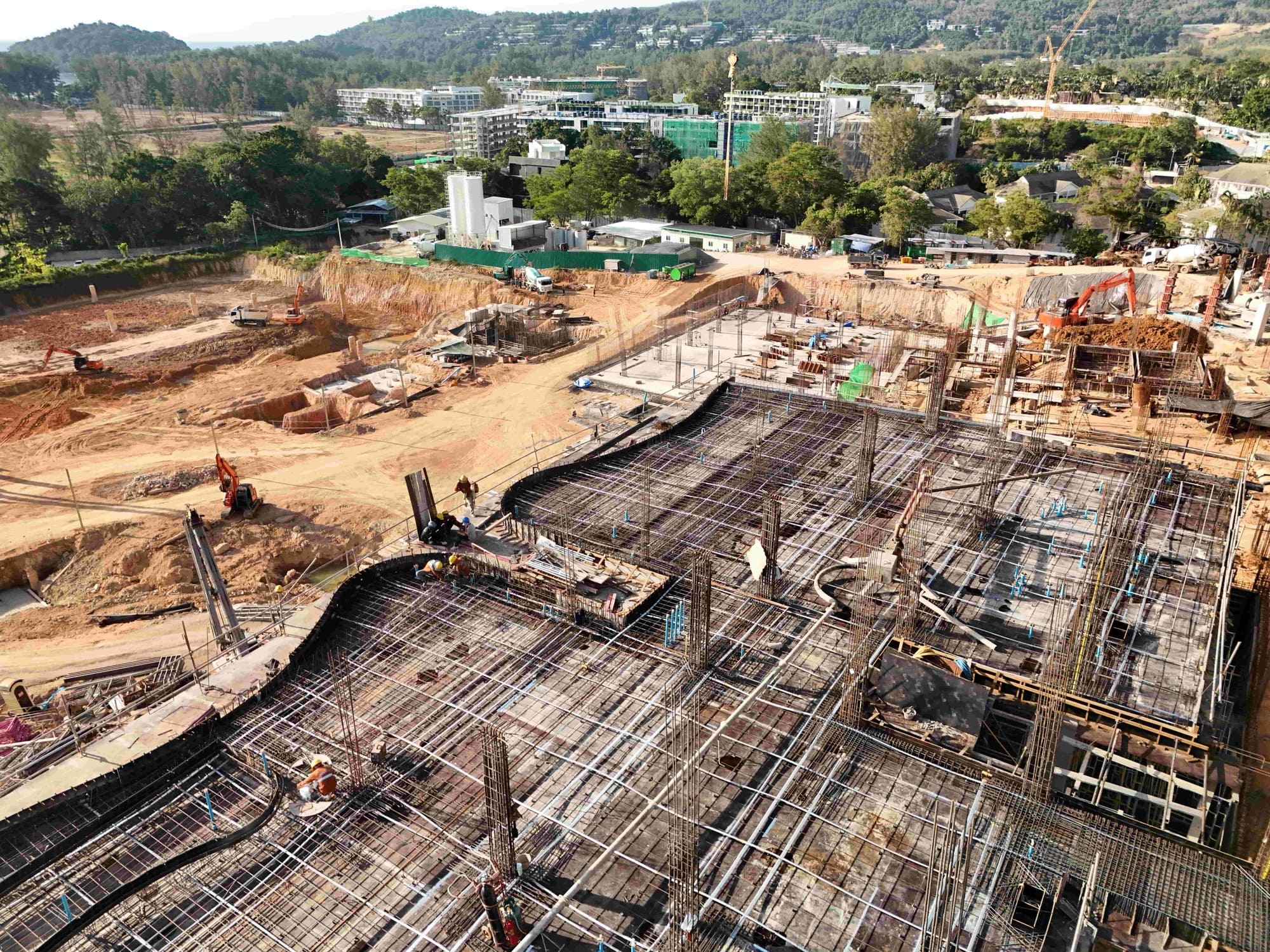

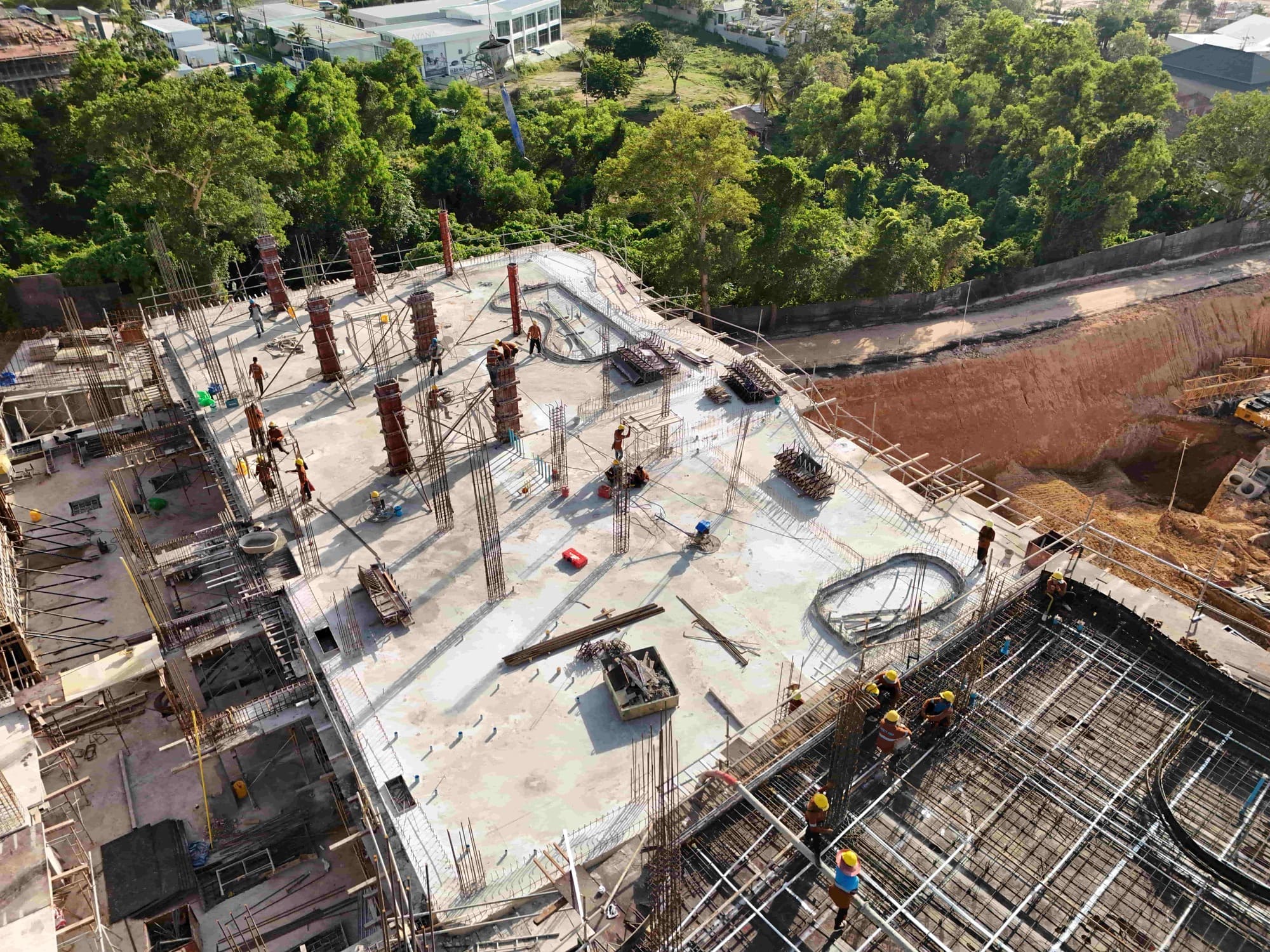

The total volume of placed structural concrete stands at 8,366 m³. Soil excavation continues, with a cumulative volume of 266,810 m³ removed. Installation of internal partition walls continues on the 2nd and 3rd floors of Building A5. In Building A2.1, casting of the 2nd-floor slab is complete, while in Building A2.2 the 3rd-floor slab is prepared for concrete placement. Formwork installation for the 2nd floor of Building A4 is underway. Foundation works for Building B8 continue, along with soil excavation works for Phase 2.
